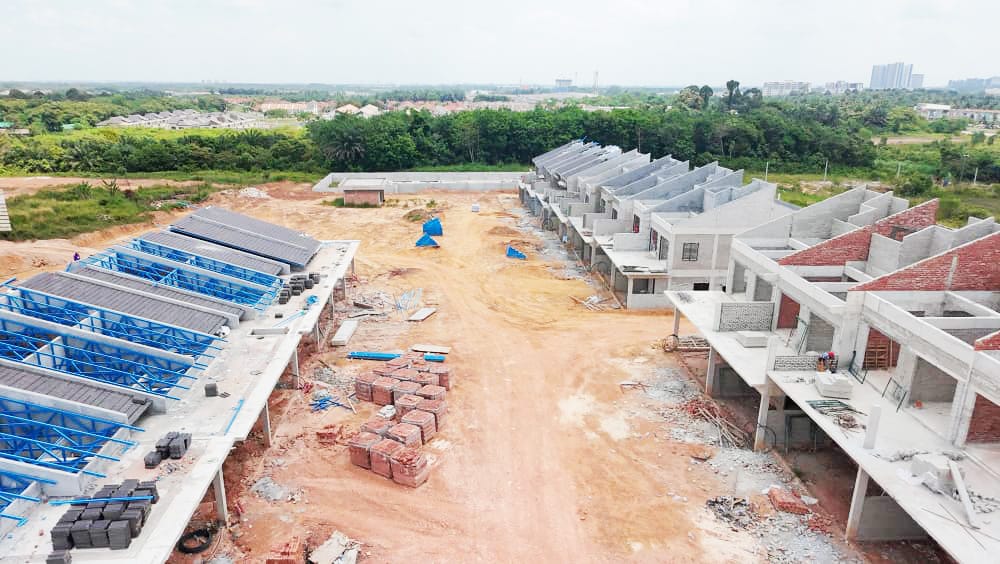

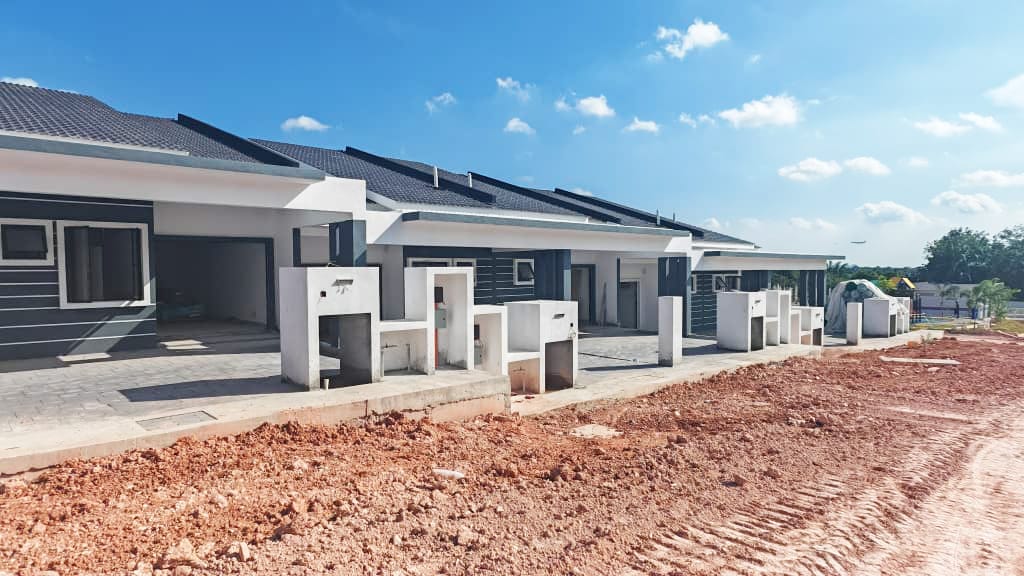

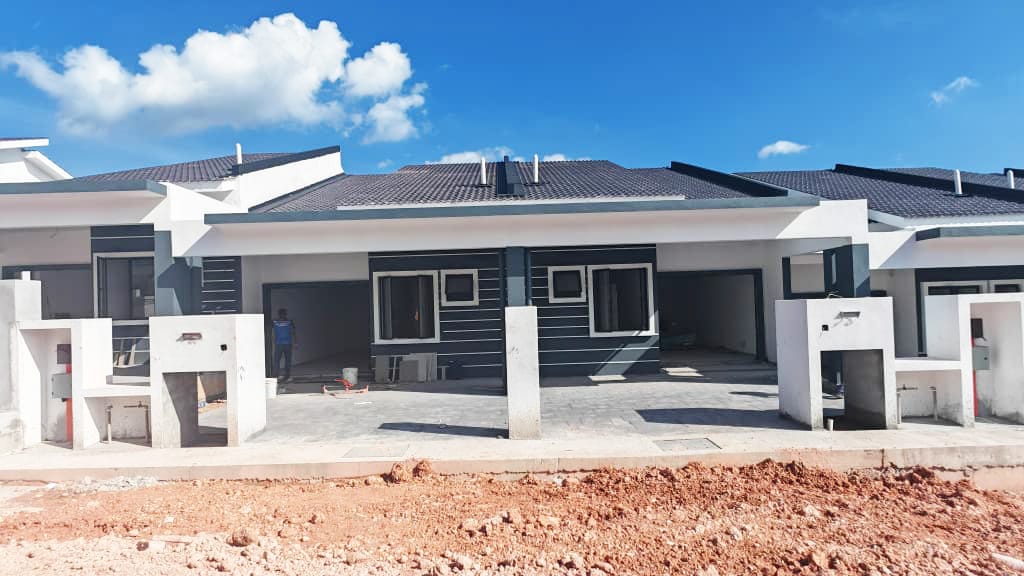

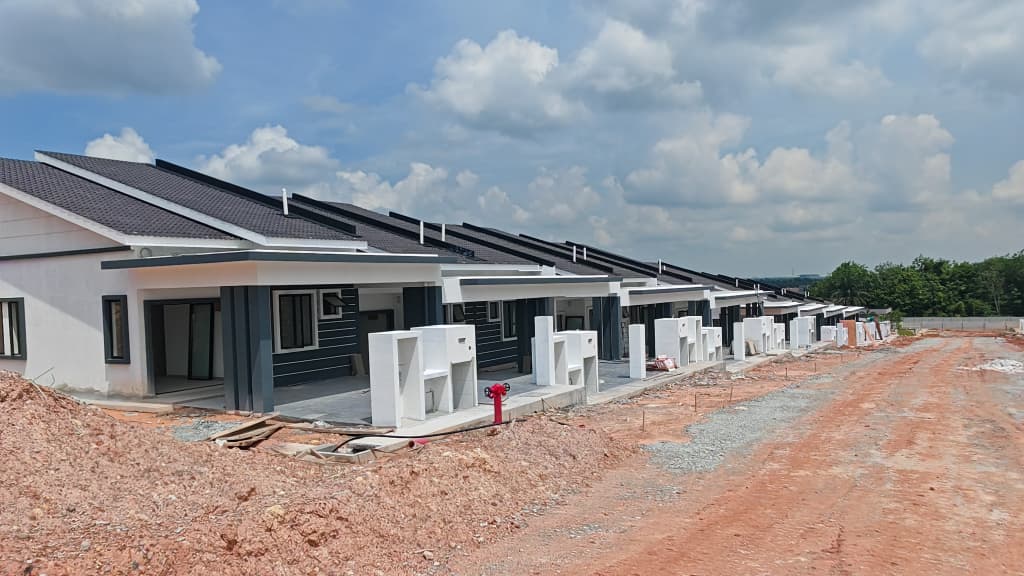

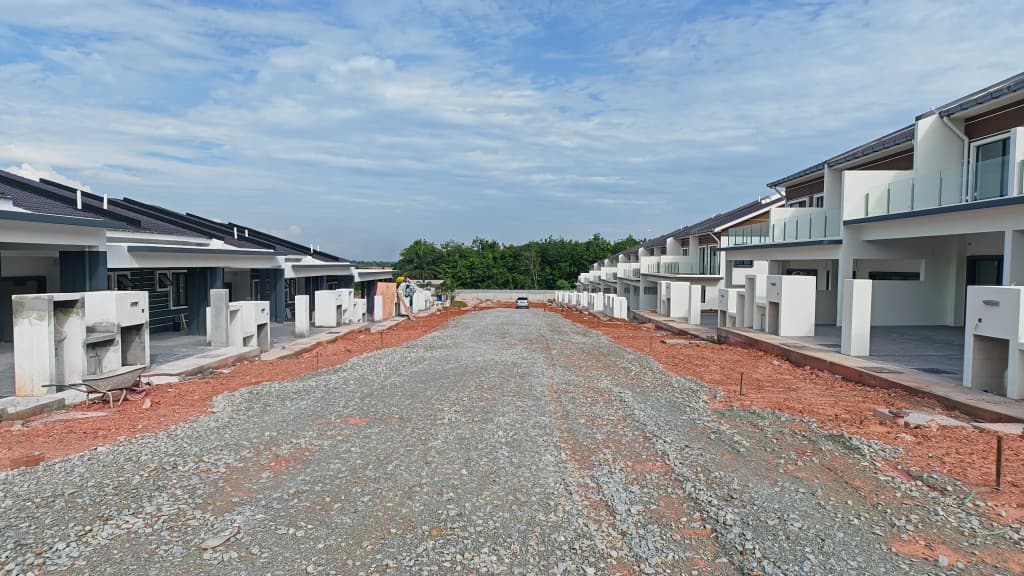

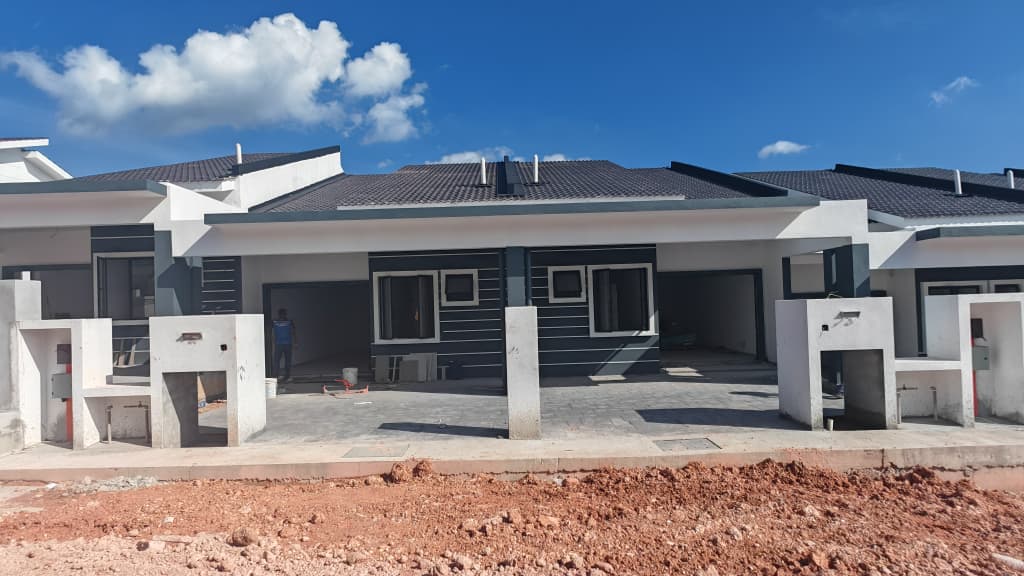

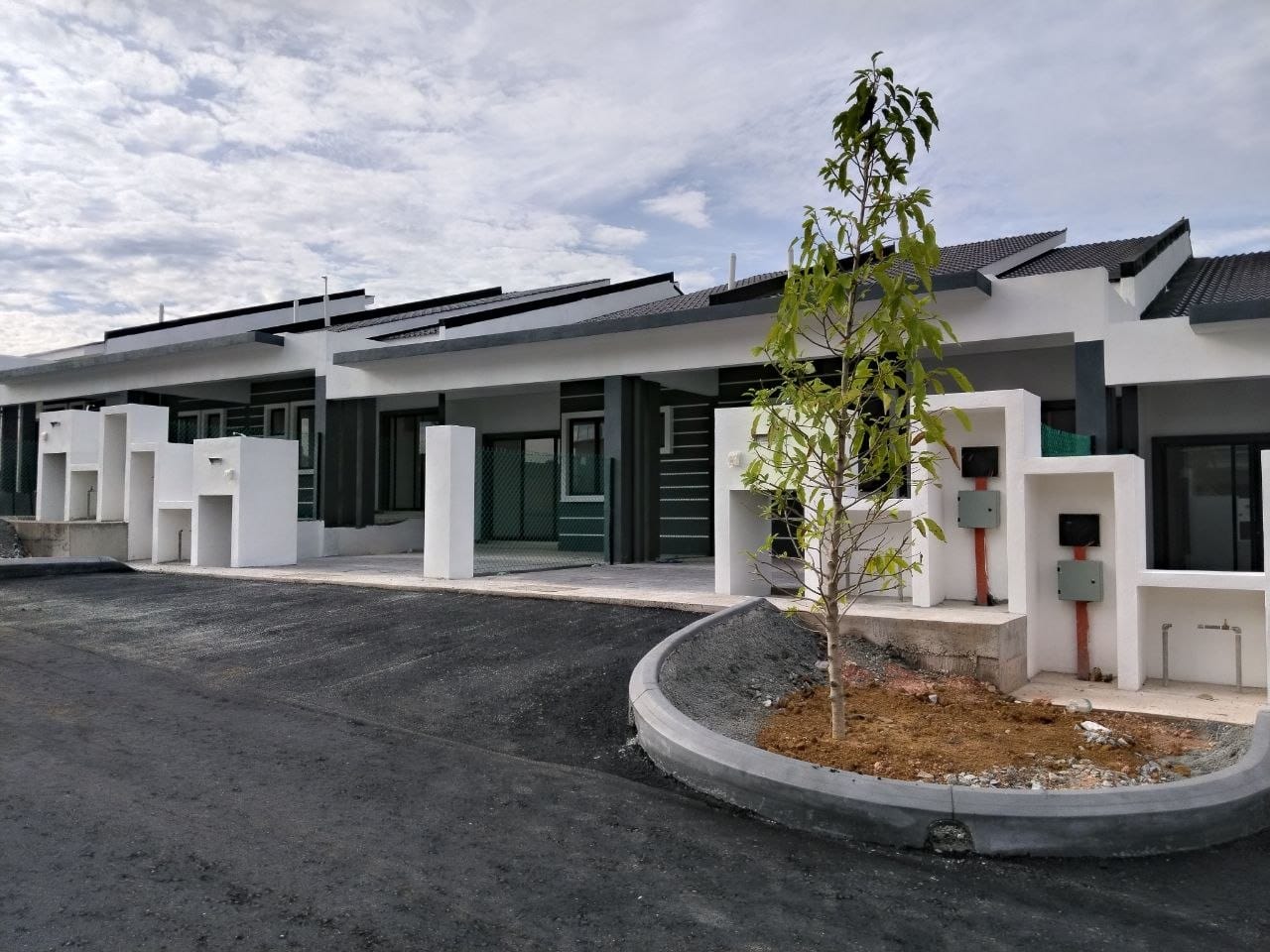

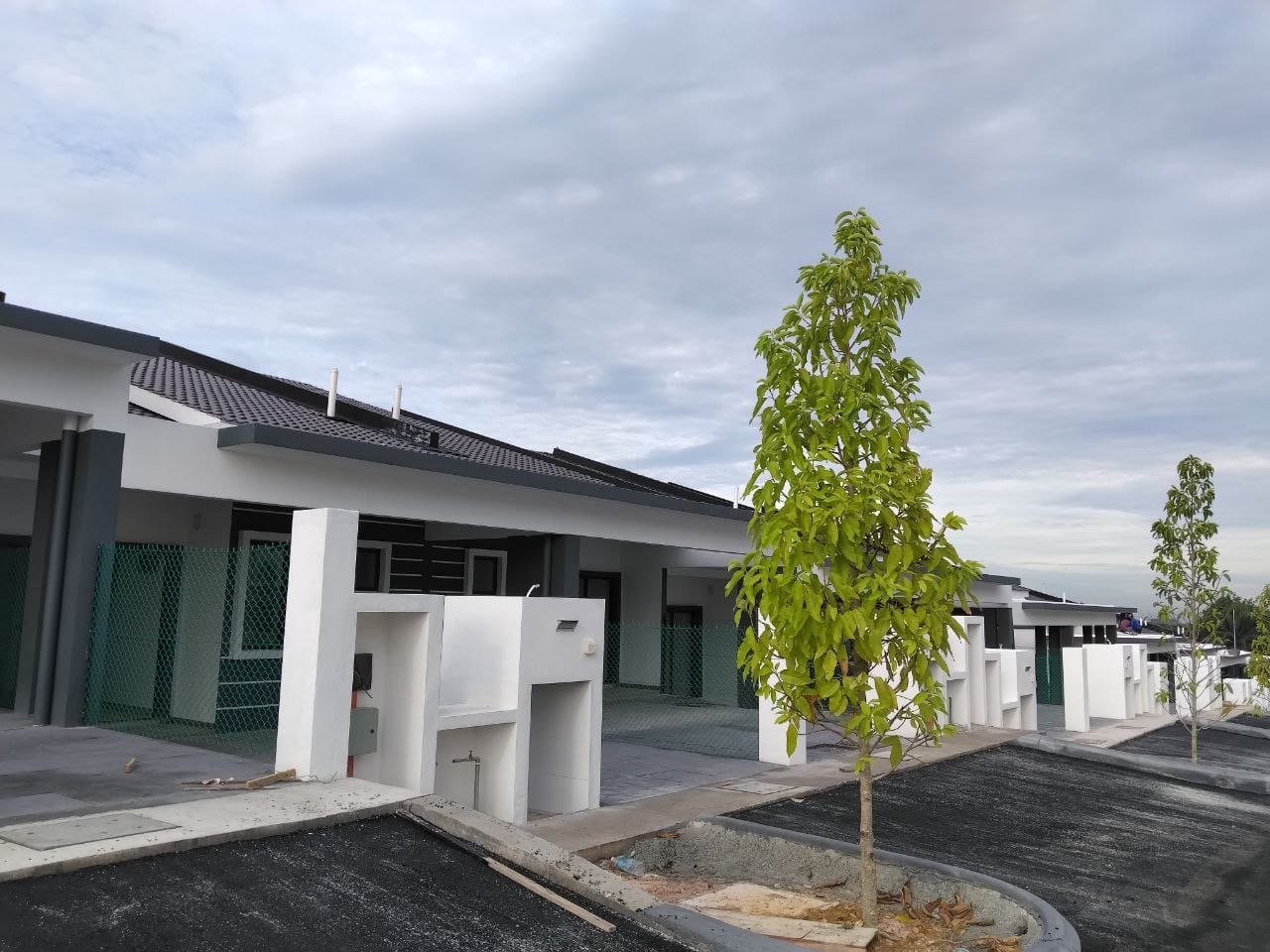

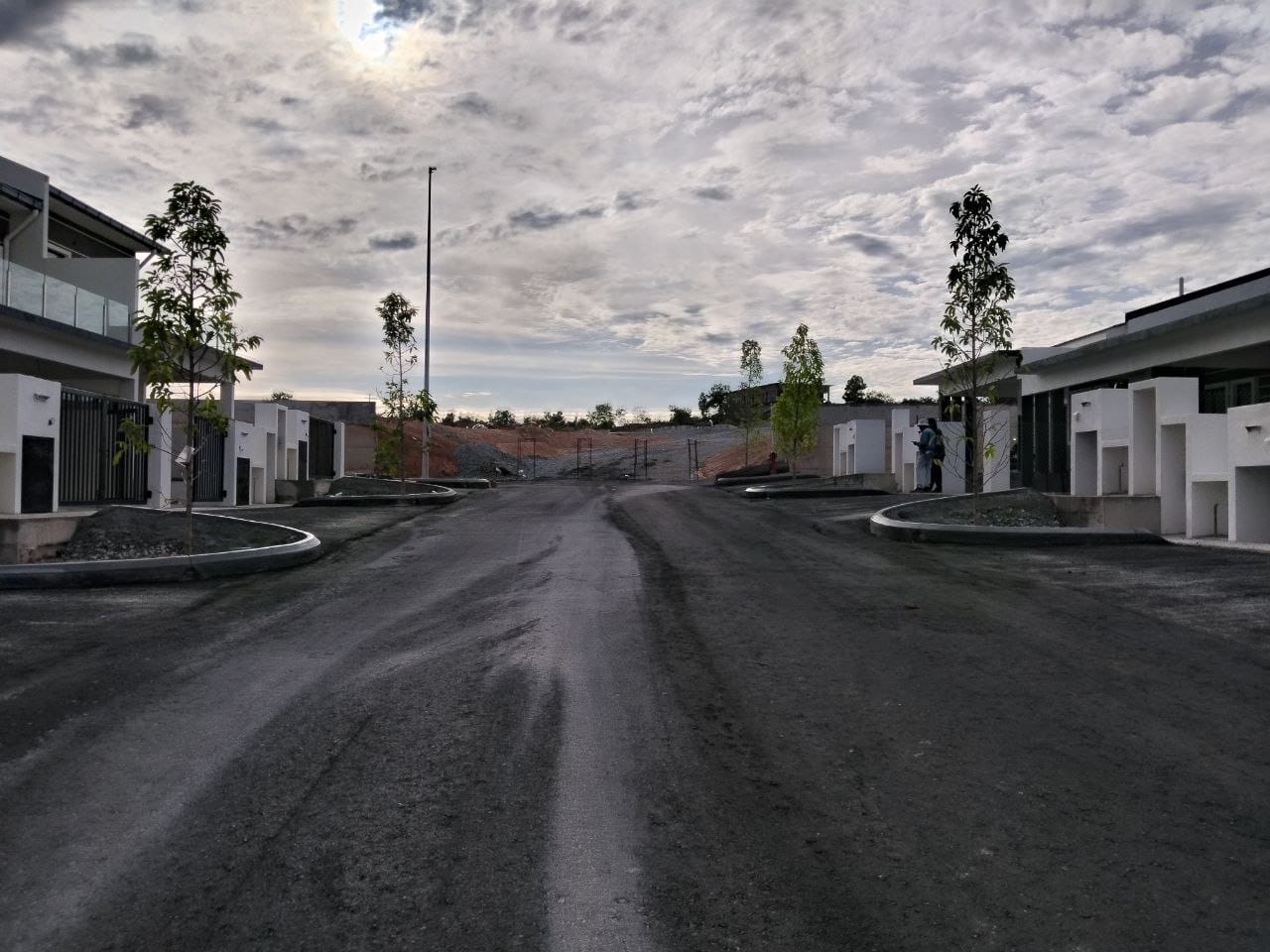

Status Projek Terkini

Taman Salak Cemara,Fasa I

Development Progress

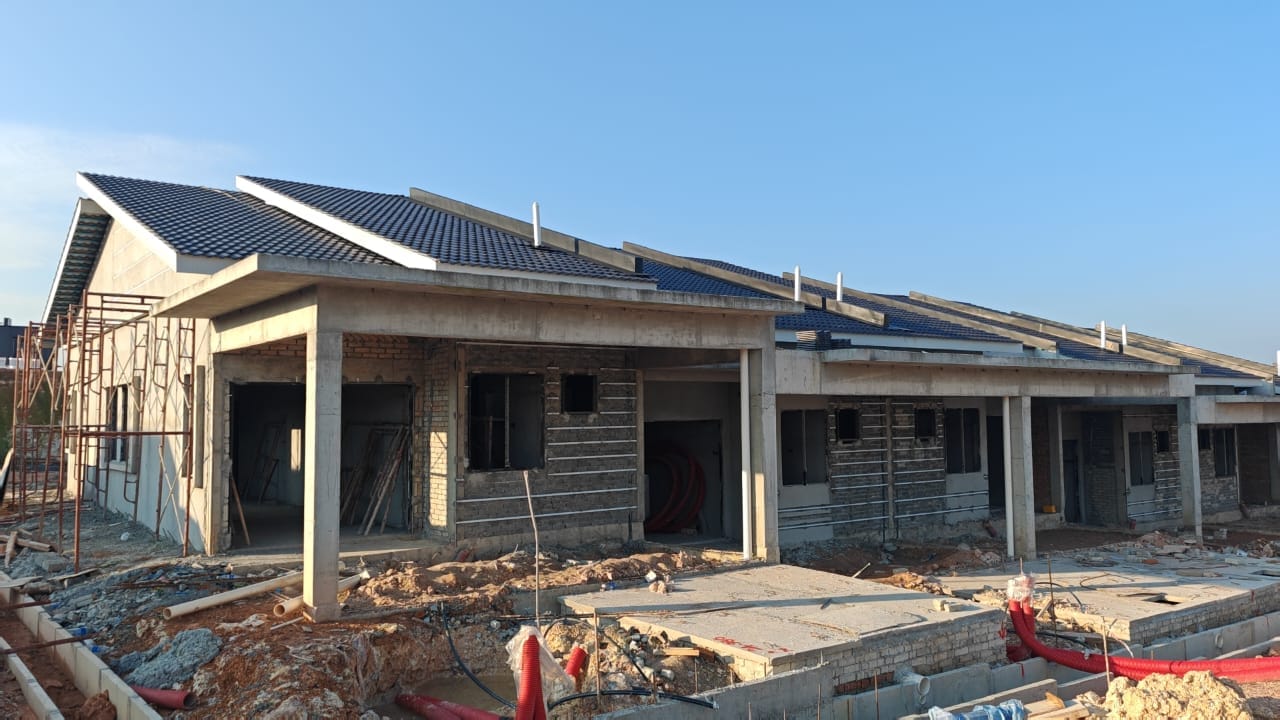

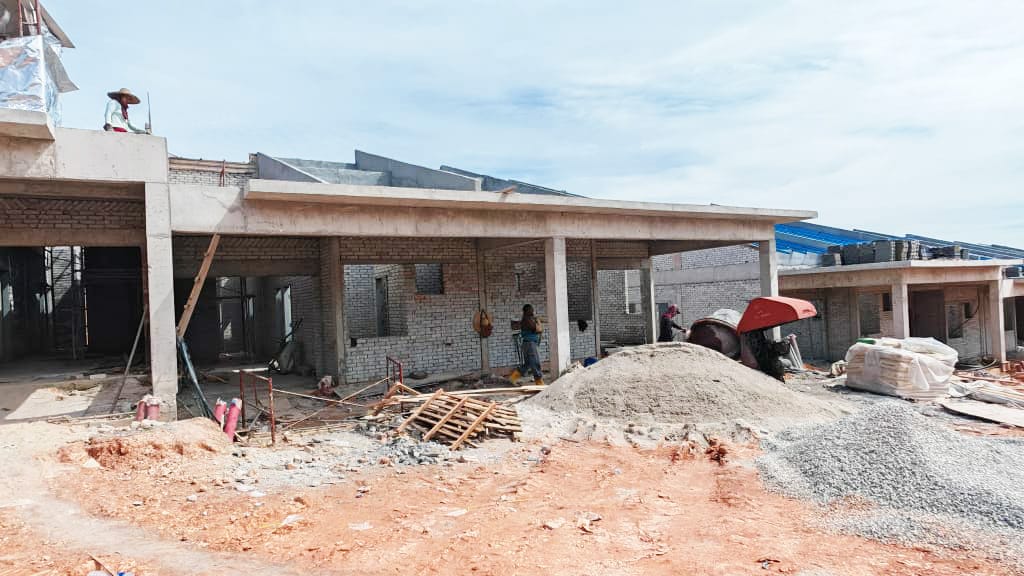

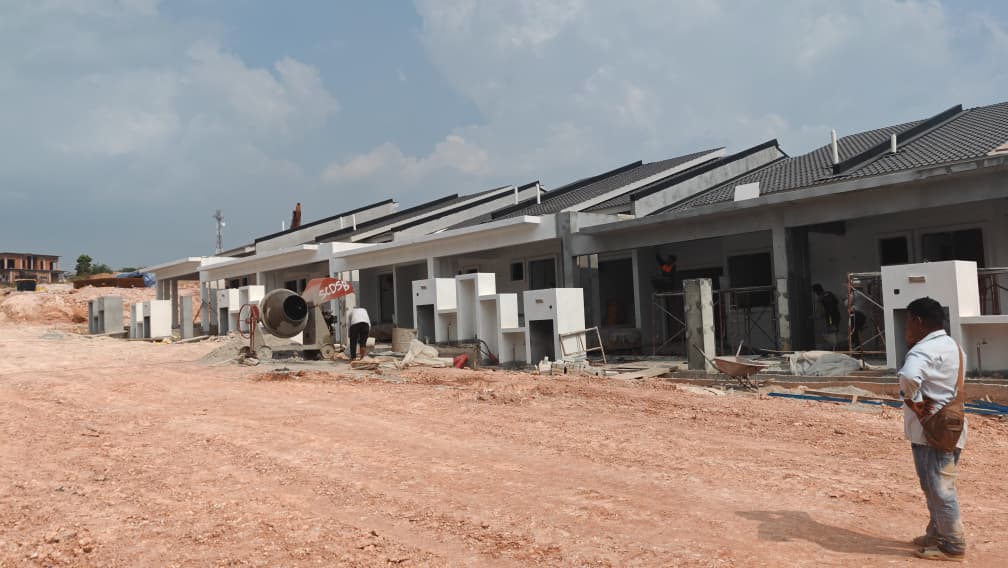

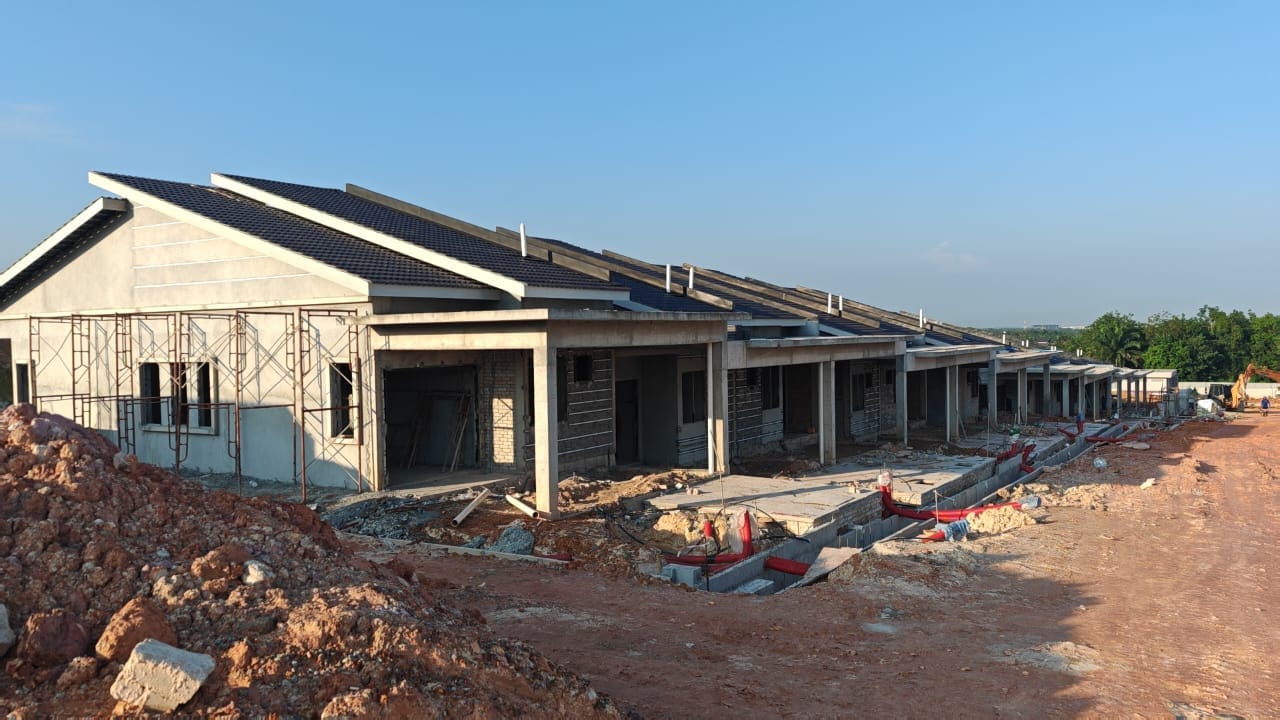

(Swipe the kiri untuk lihat lebih)

Setting Out Progress
20%

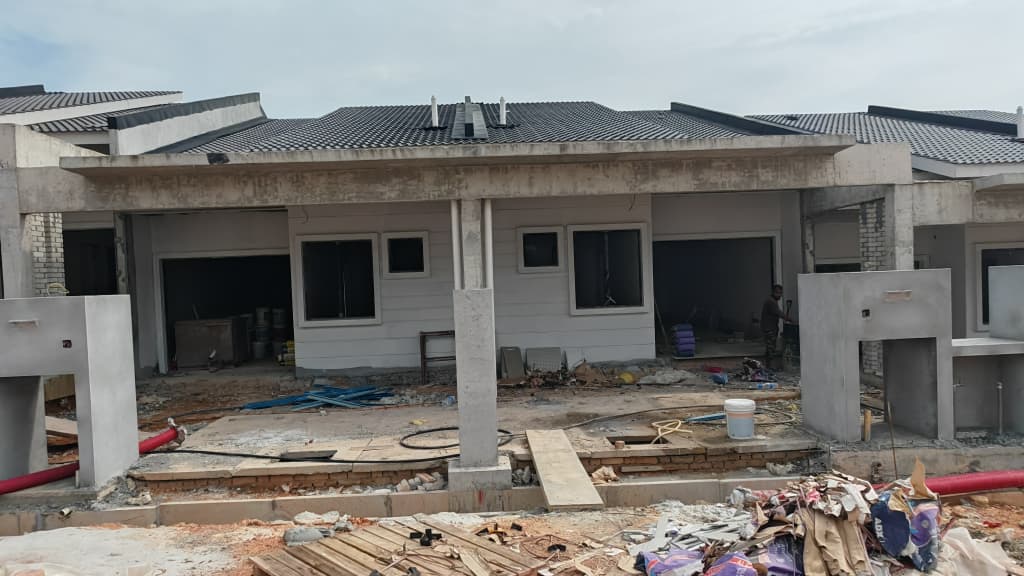

Concrete Footing
20%
Installation House Manhole VCP Pipes
30%
TNB Stump & Trenches
20%
Compacted Earth & Install Underground Pipes
30%
Install BRC & Plastic Sheet
20%

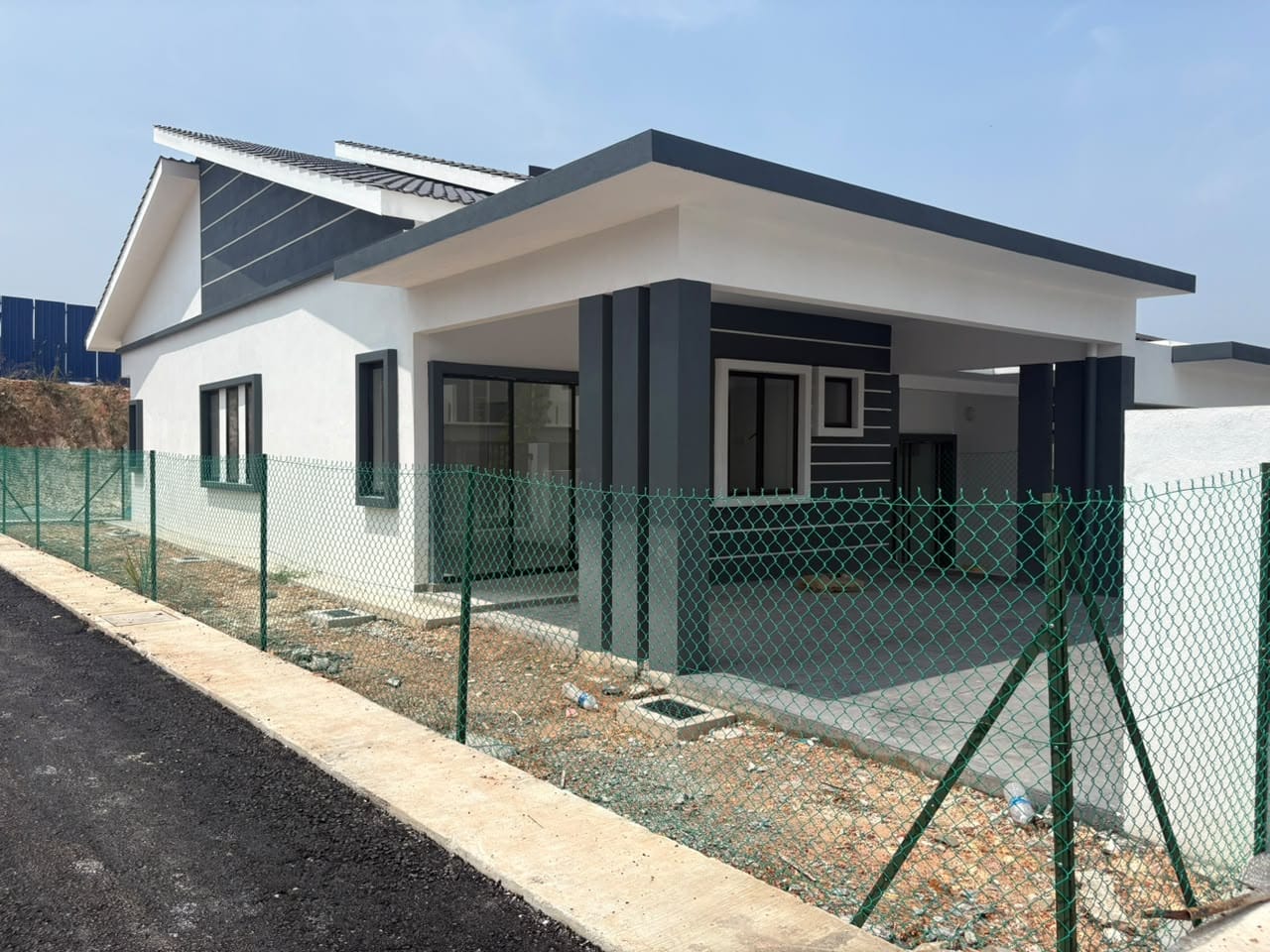

3D Model

Project Location

Construction of a Sewage Treatment

Setting Out | 3 August 2024

TNB Stump & Trenches | 16 August 2024

Column Formwork | 26 September 2024

Concrete Footing | 10 October 2024

Ground Beam Formwork | 30 October 2024

Install Underground Pipes | 2 November 2024

Lay Crusher Run Hardcore & Flatten | 14 November 2024

Slab Concrete & Install Underground Pipe | 25 November 2024

Install Underground Pipe | 26 November 2024

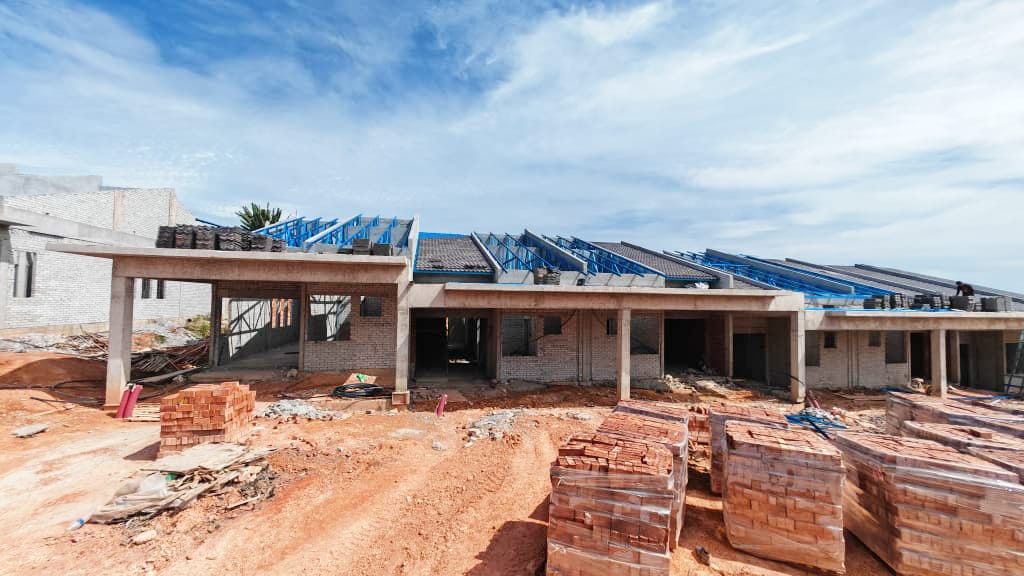

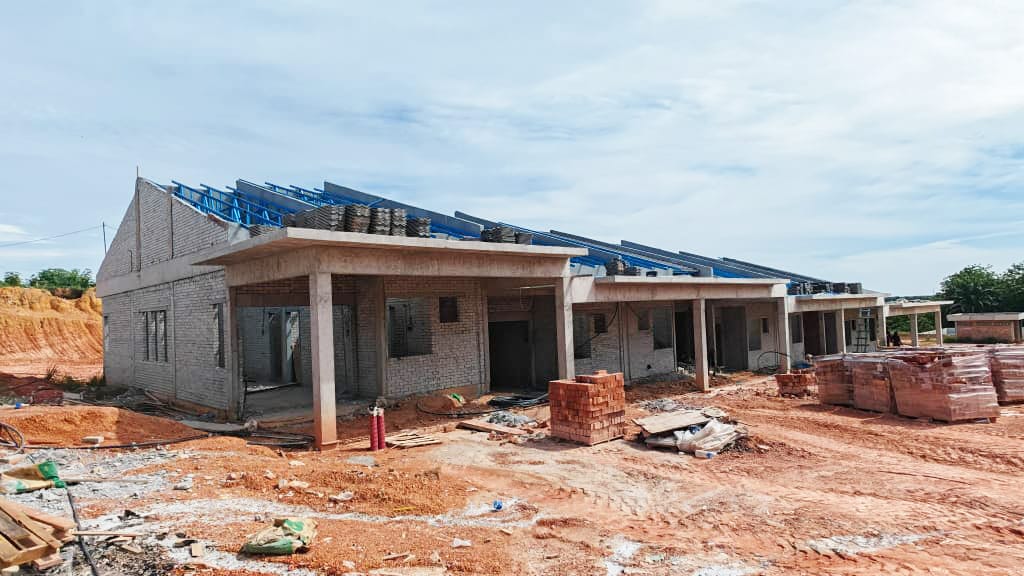

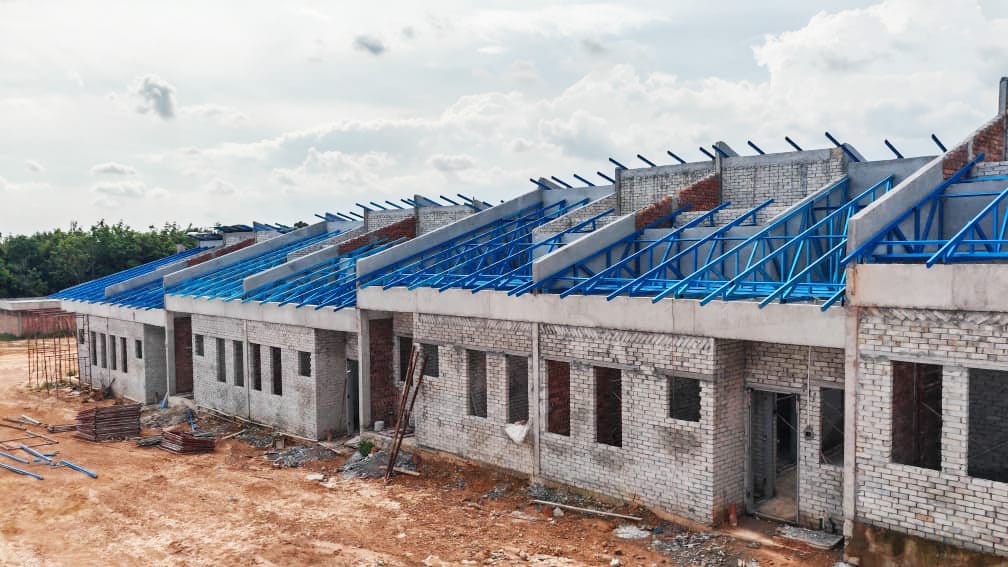

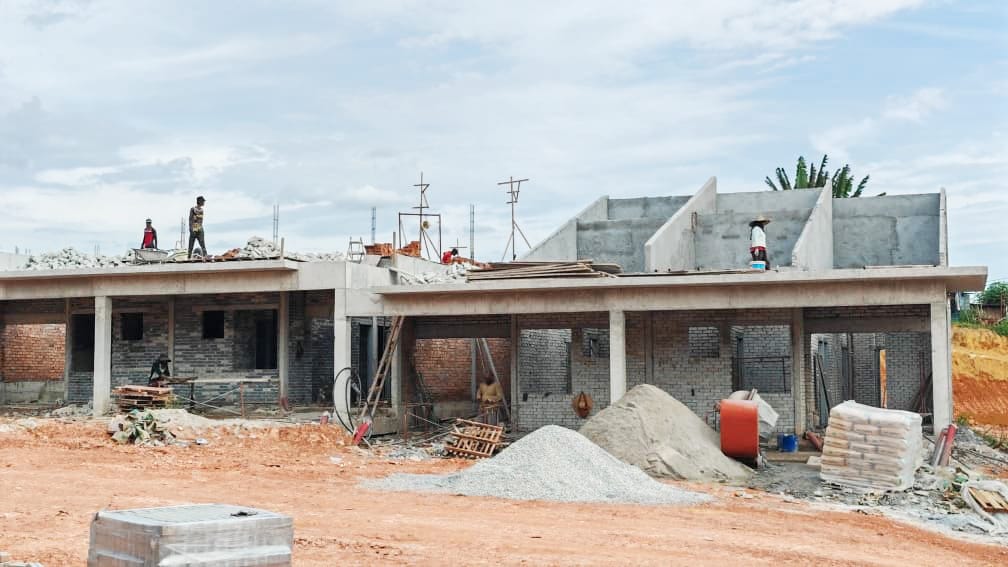

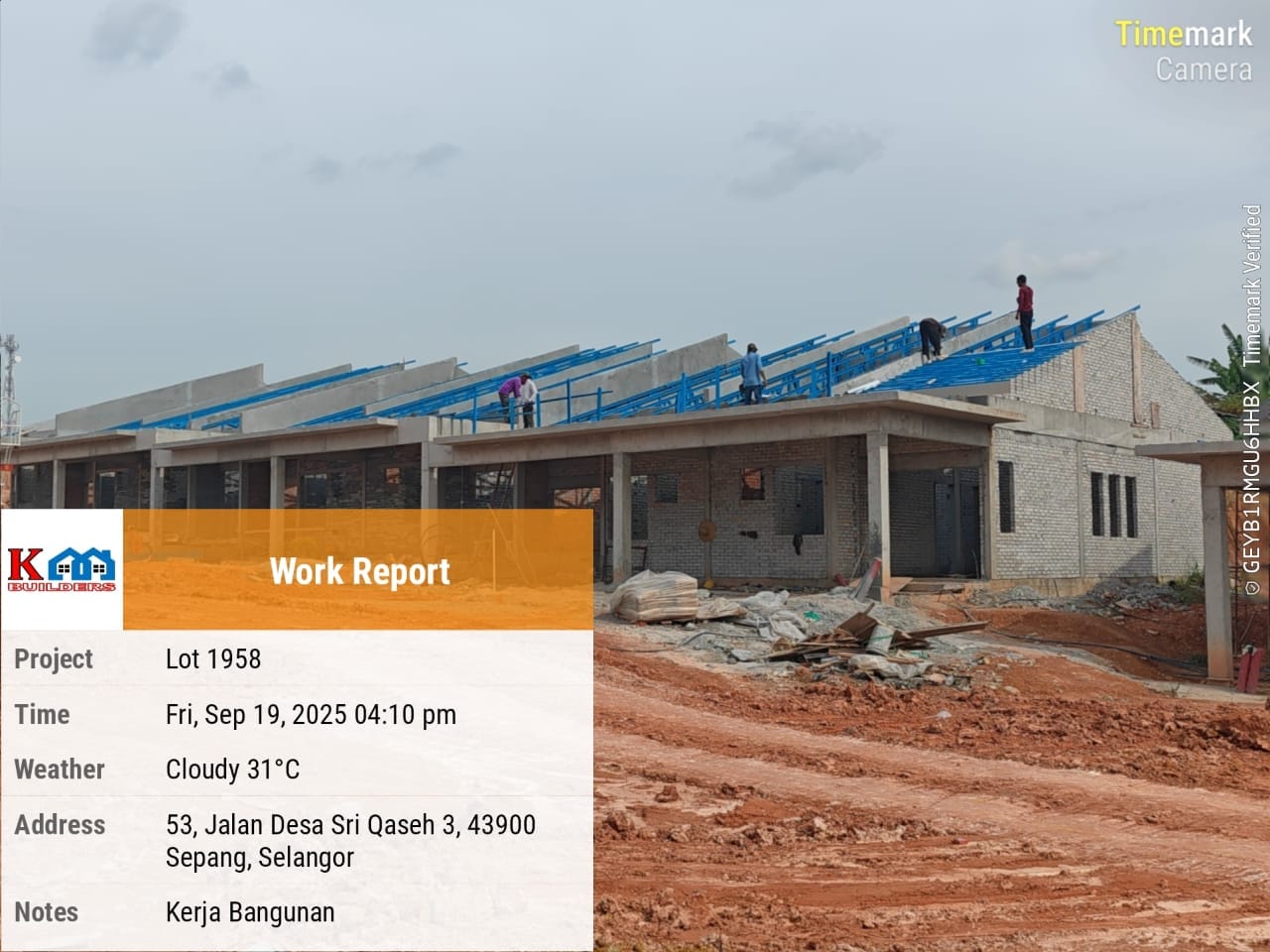

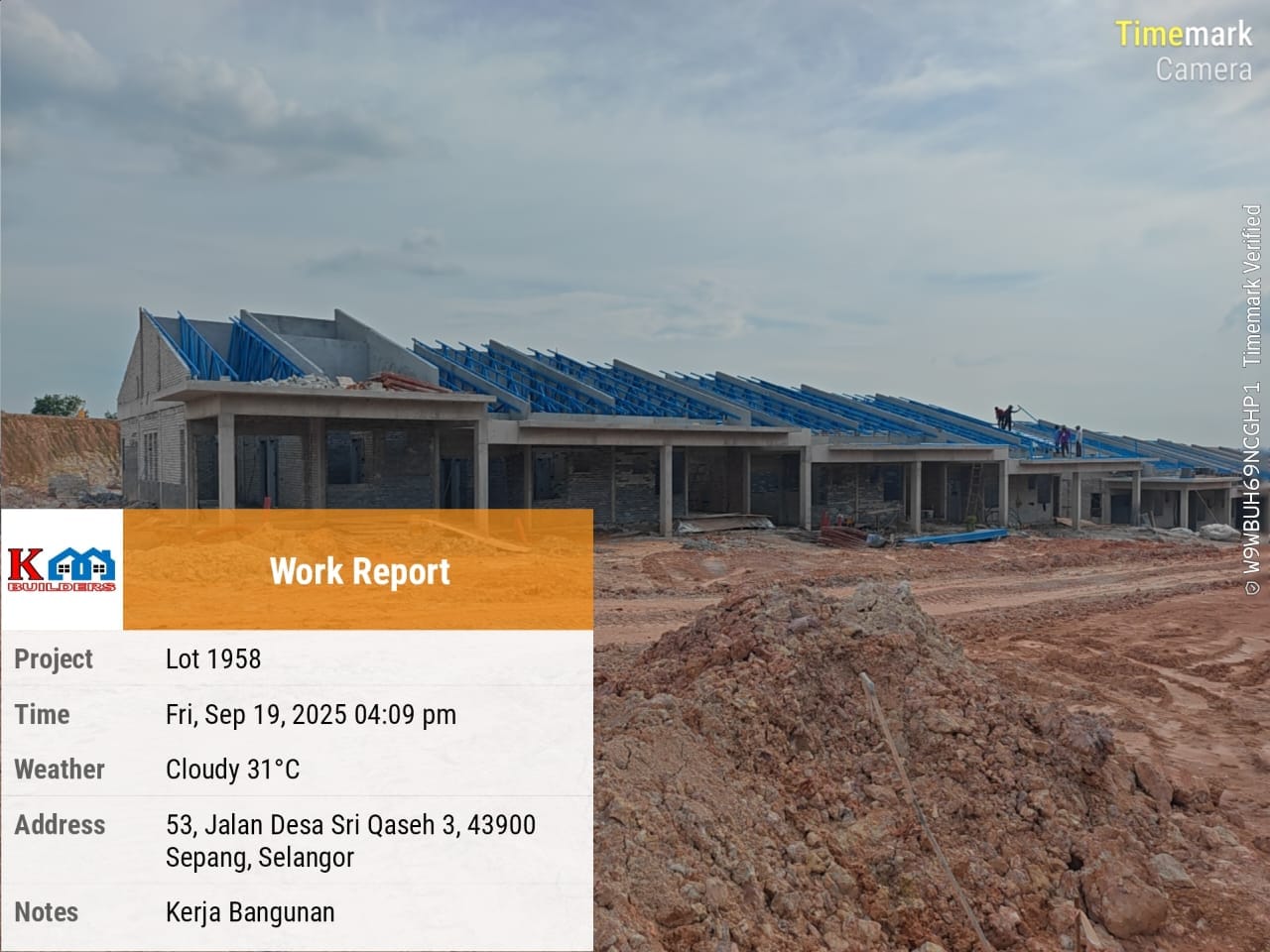

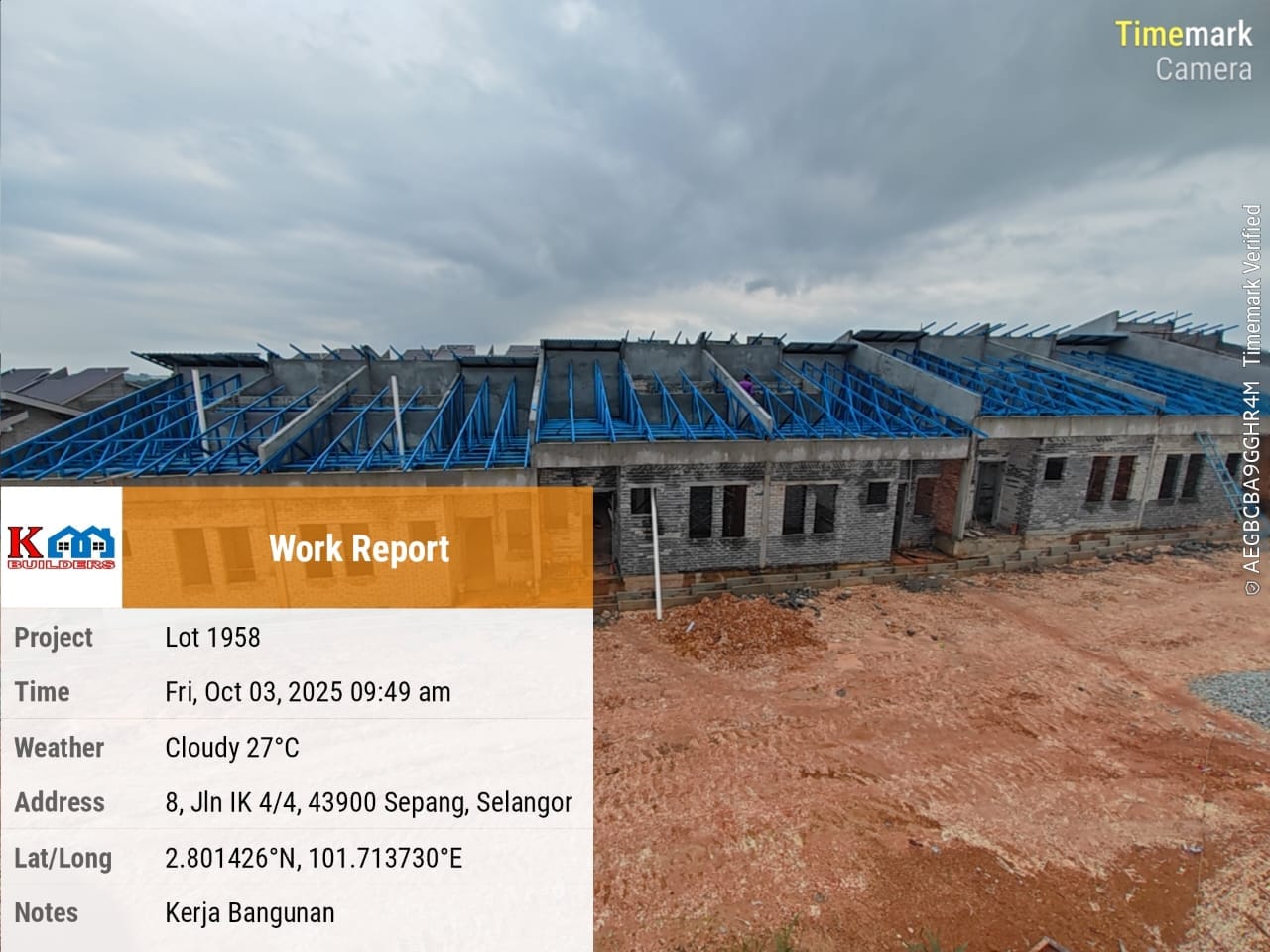

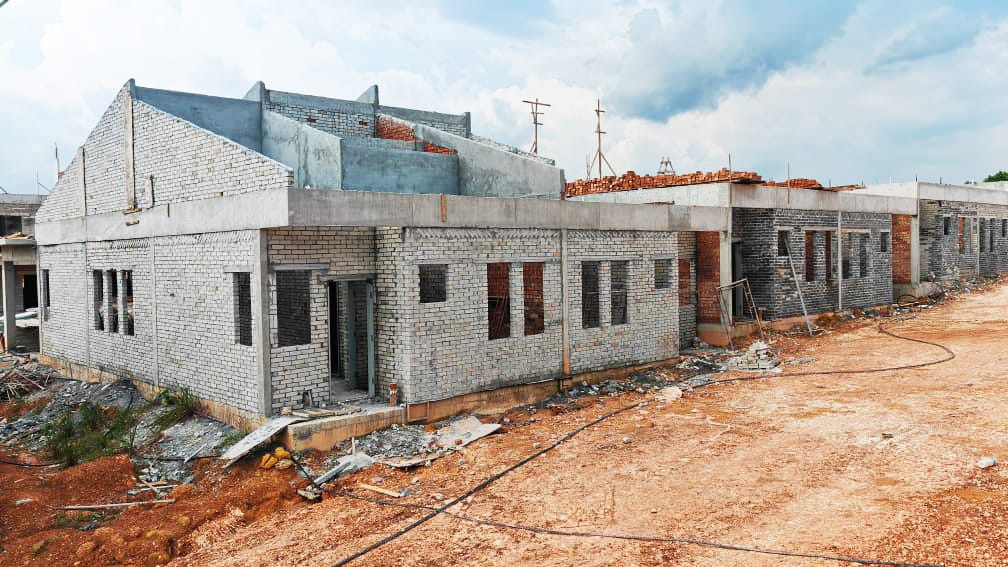

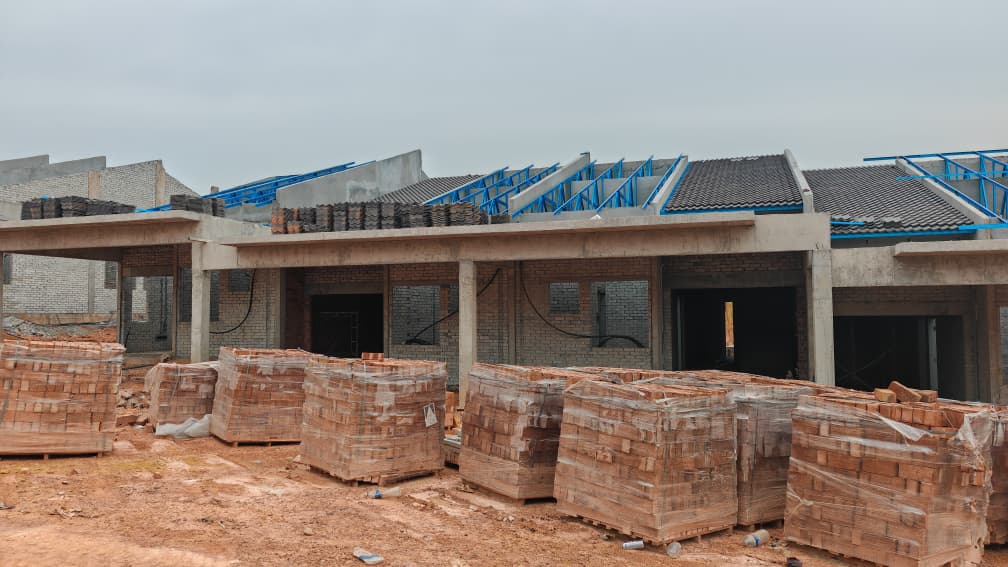

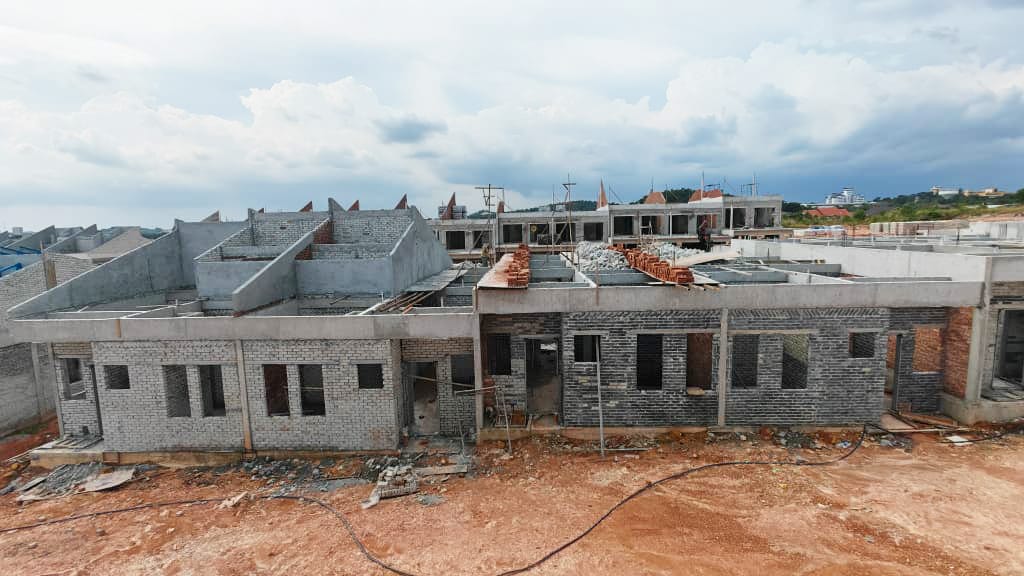

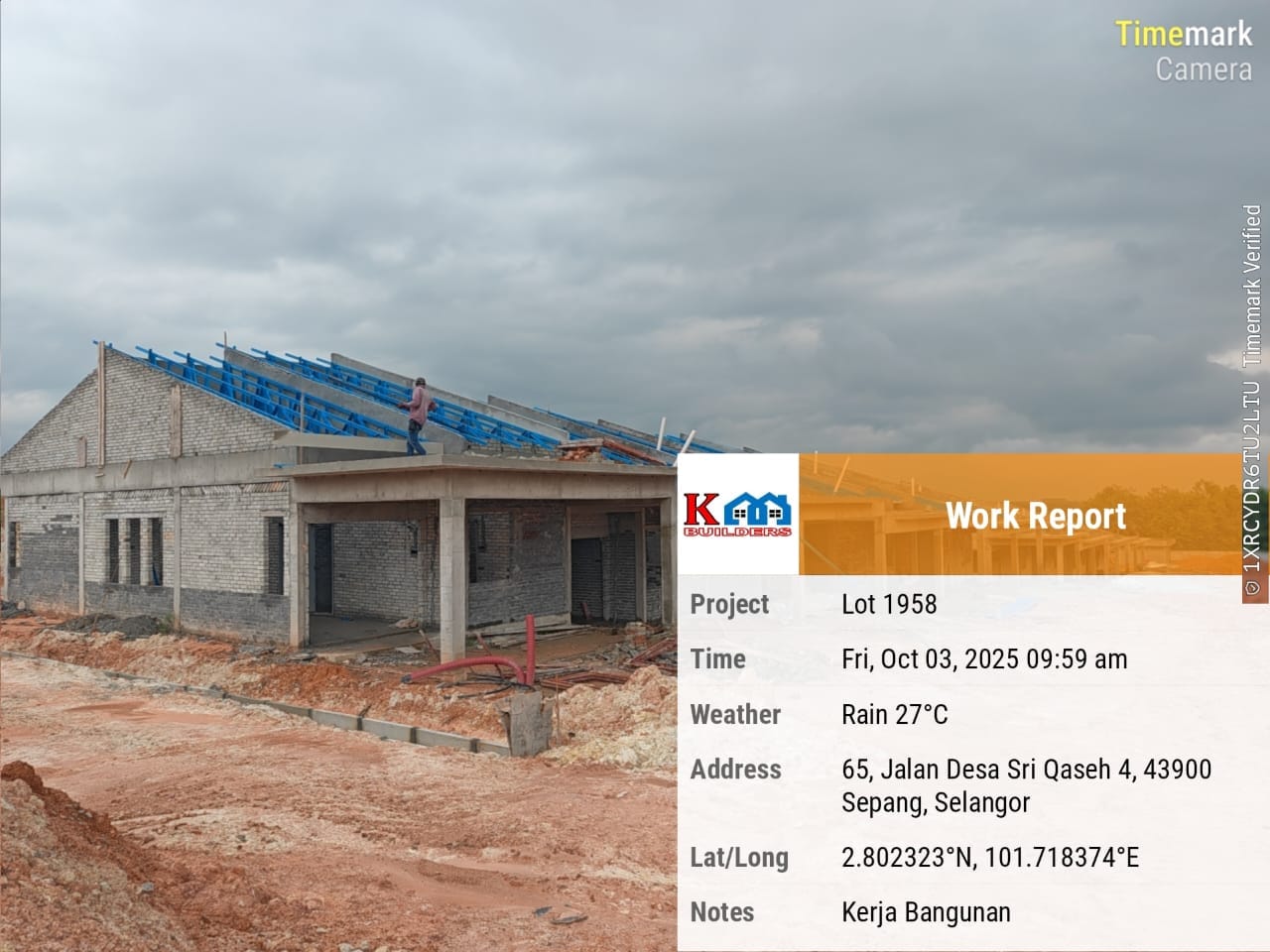

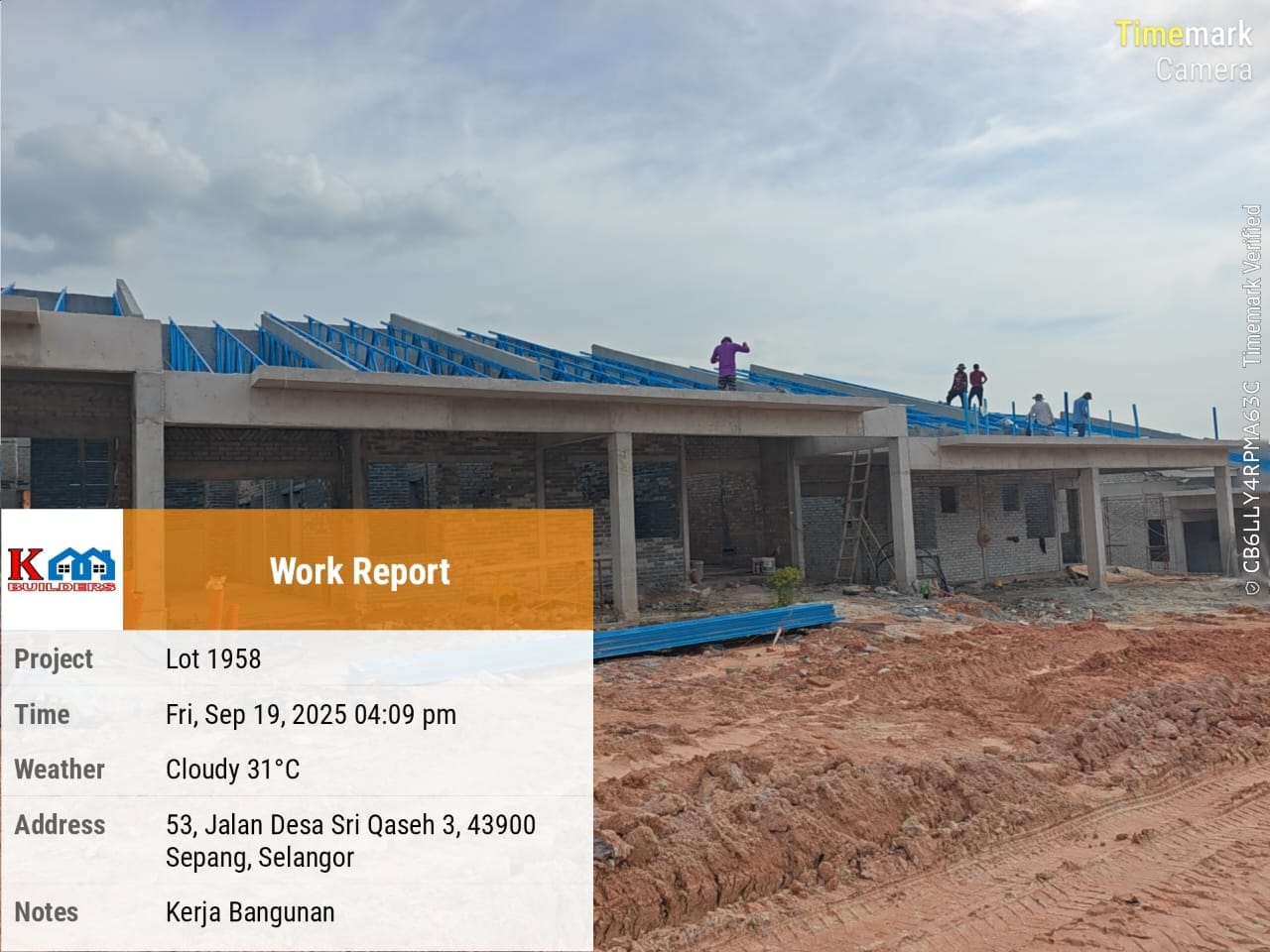

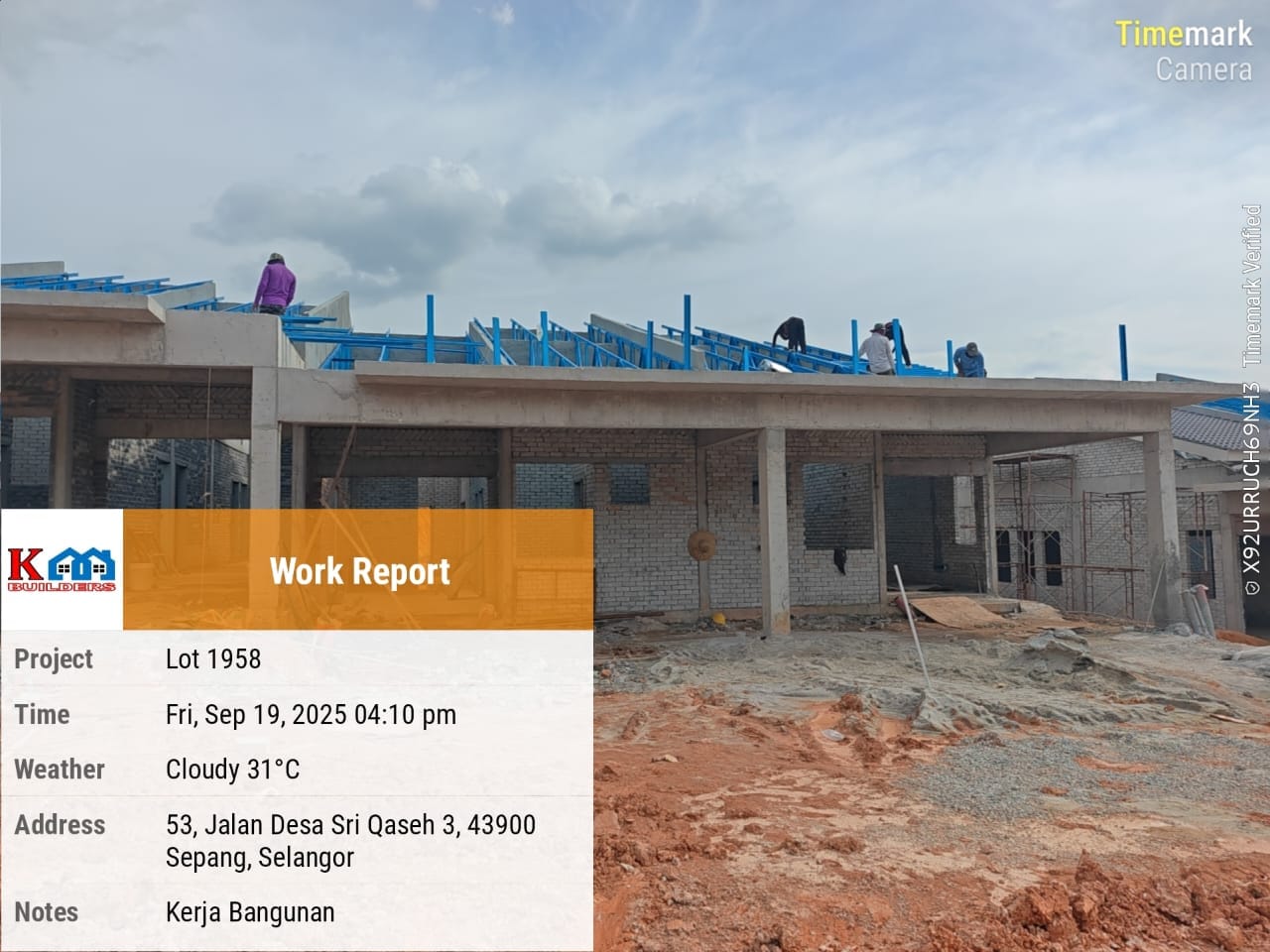

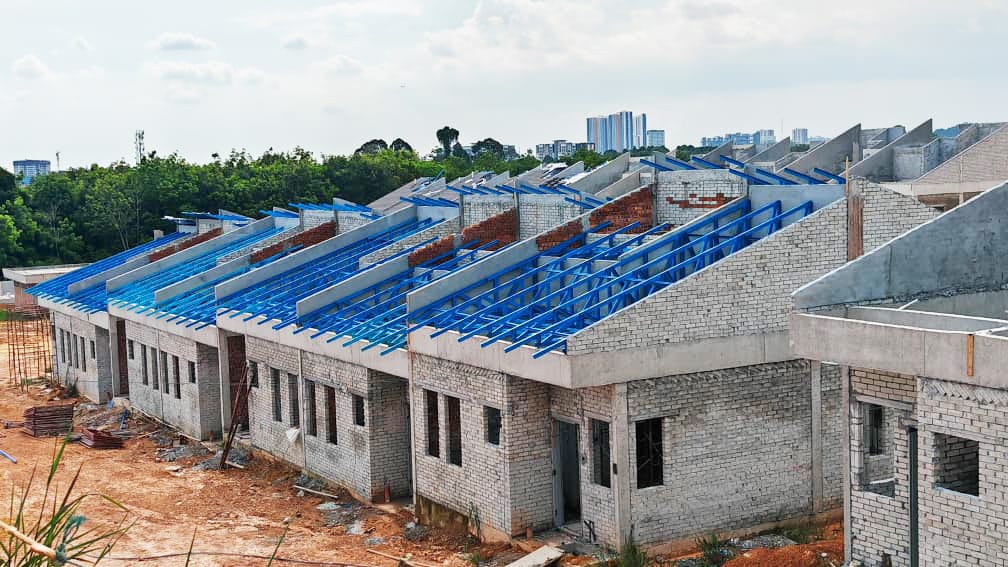

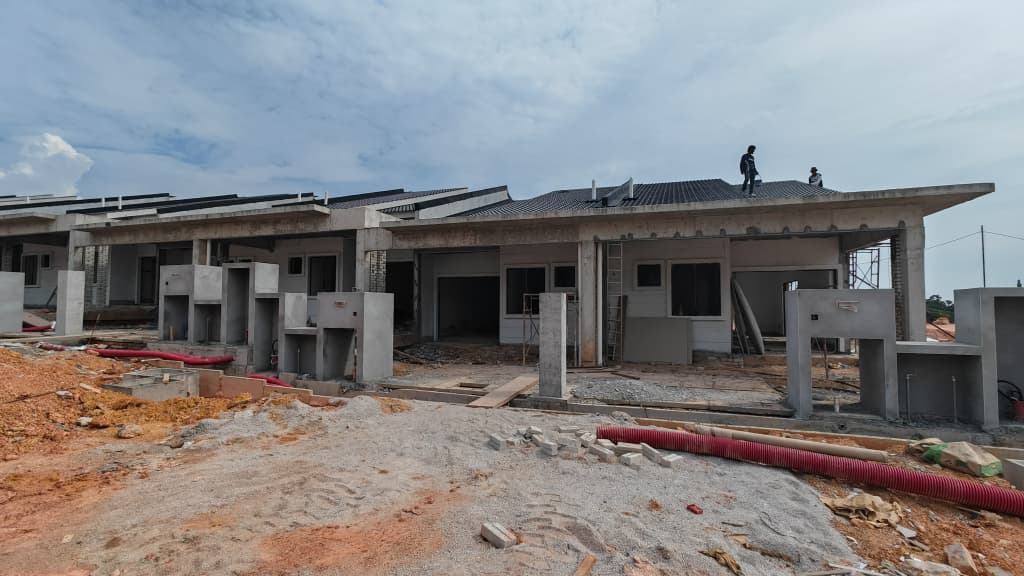

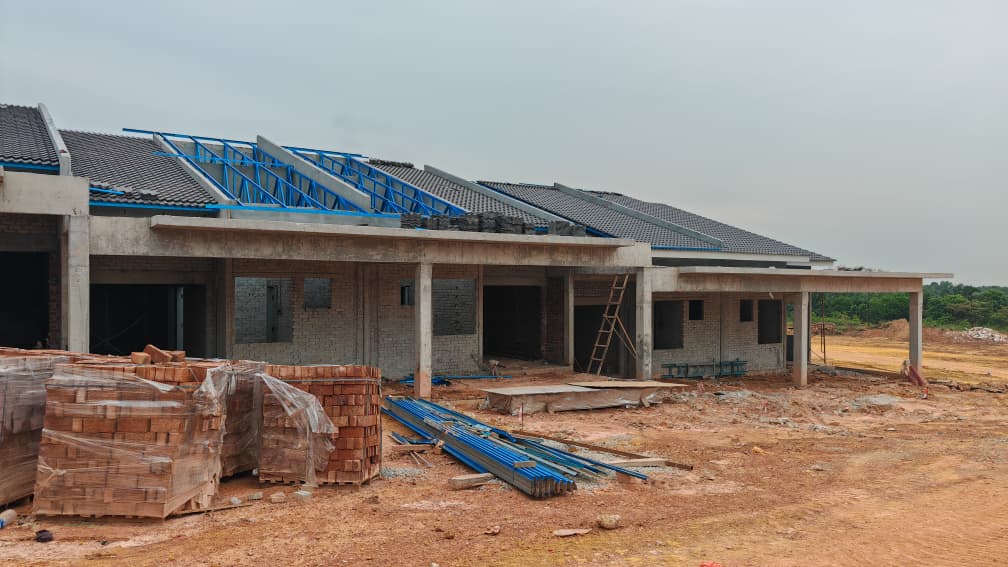

Install Roof Beam Formworks | 14 December 2024

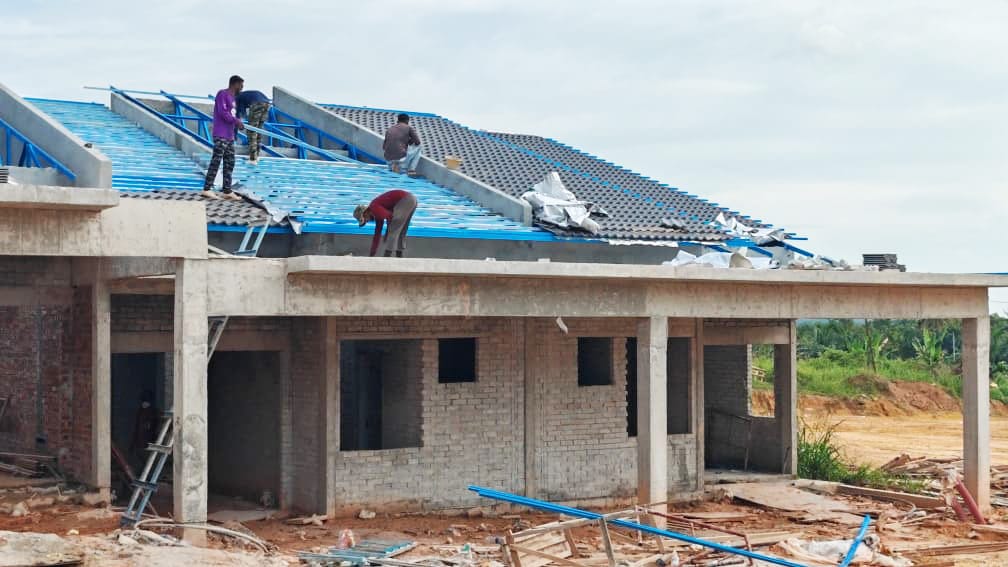

Roof Beam Formwork | 26 December 2024

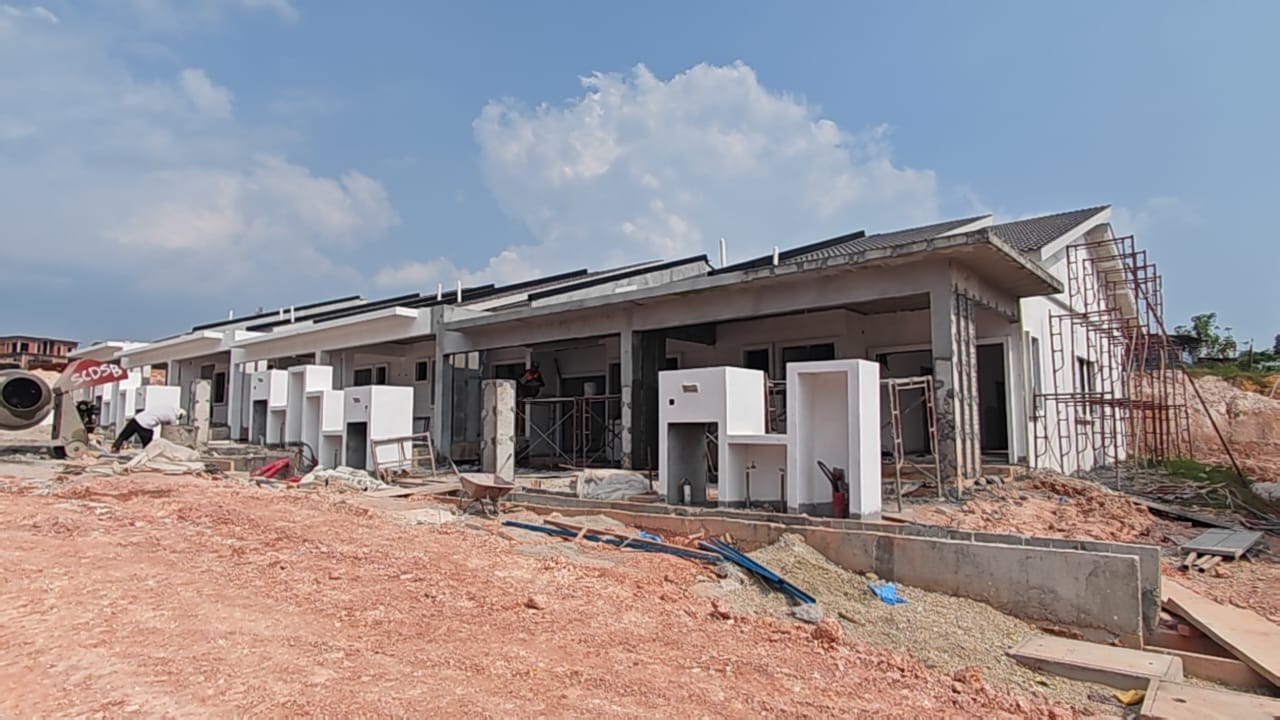

Remove Roof Beam Formwork | 18 January 2025

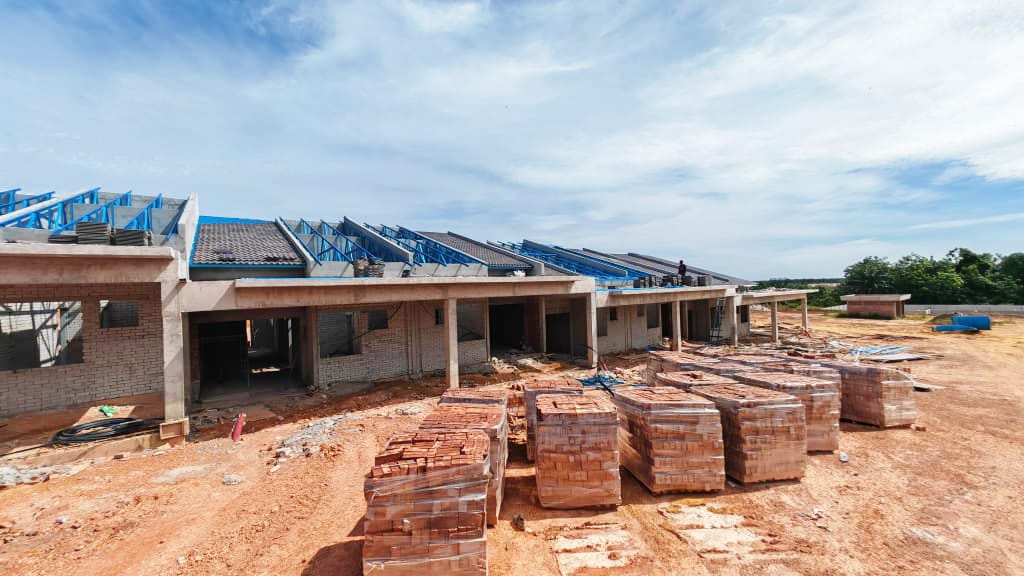

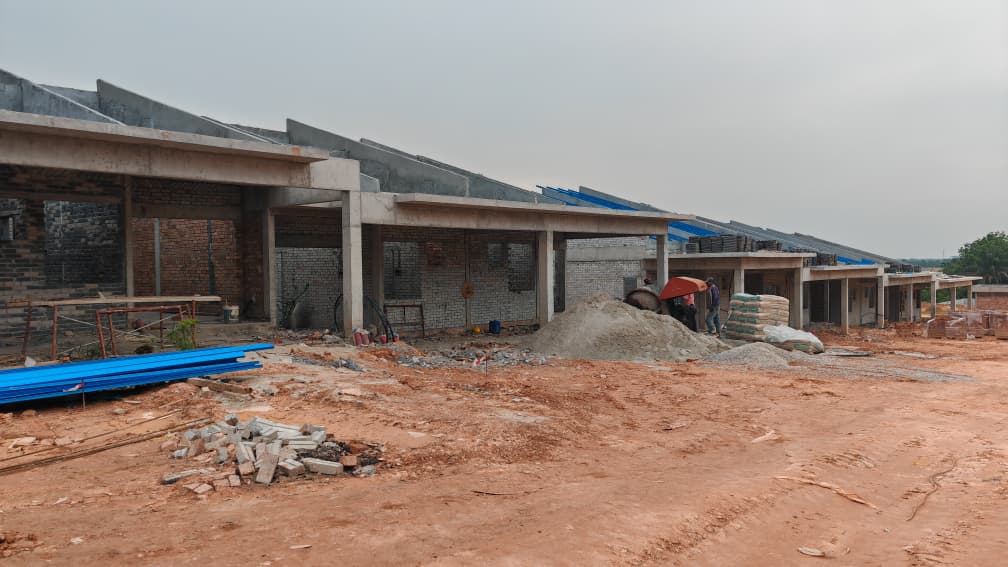

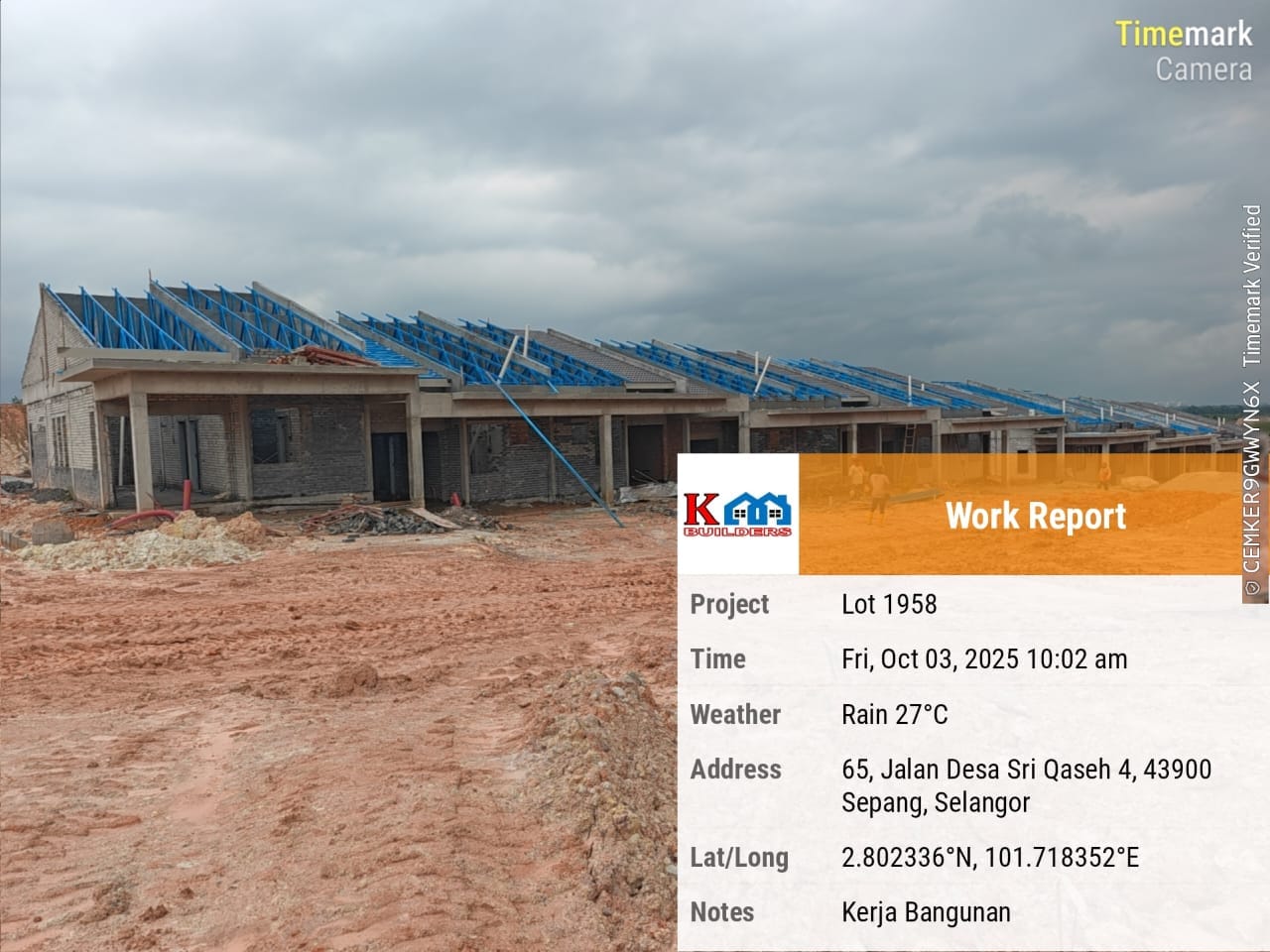

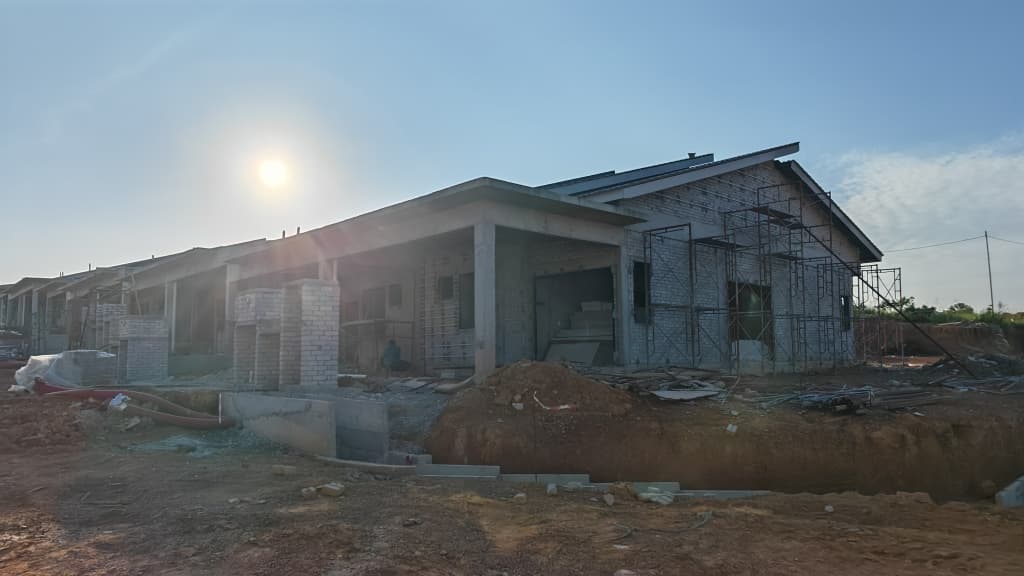

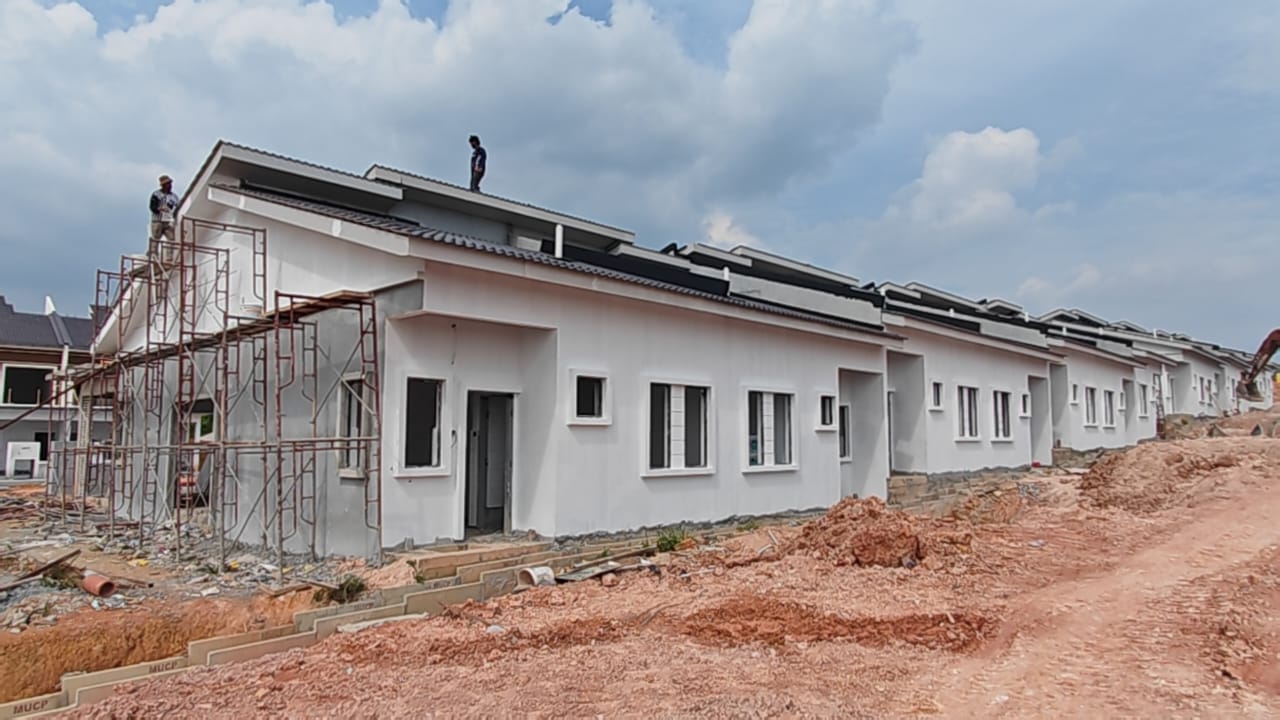

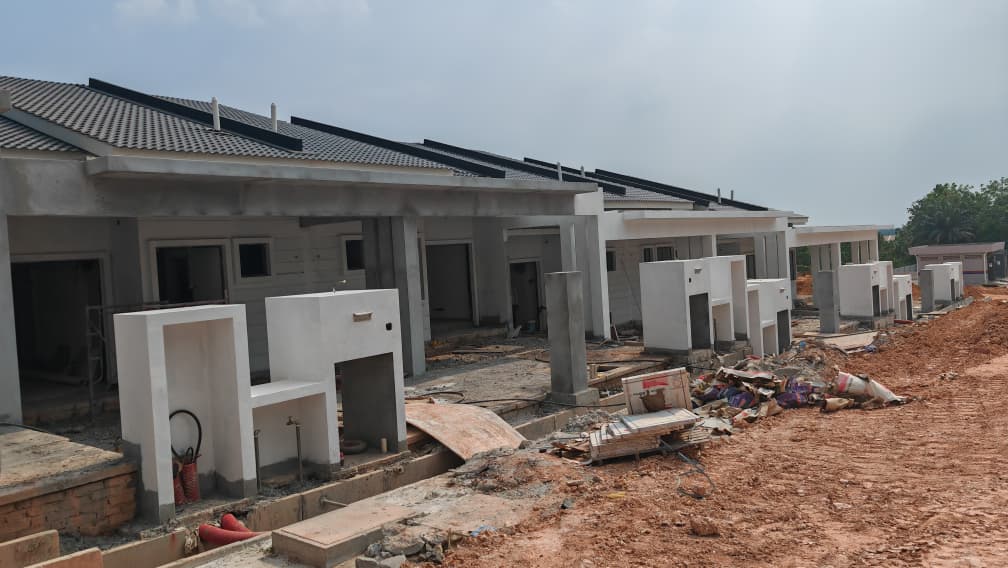

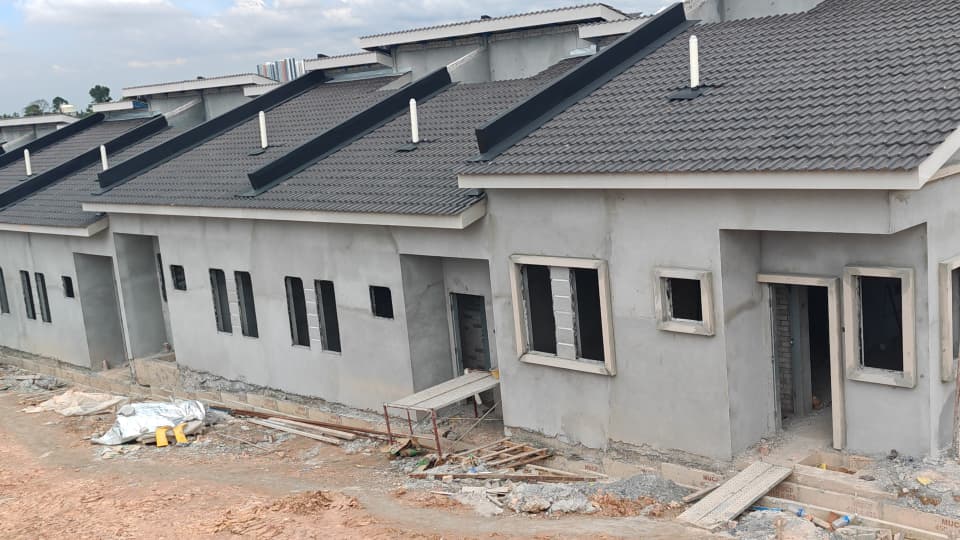

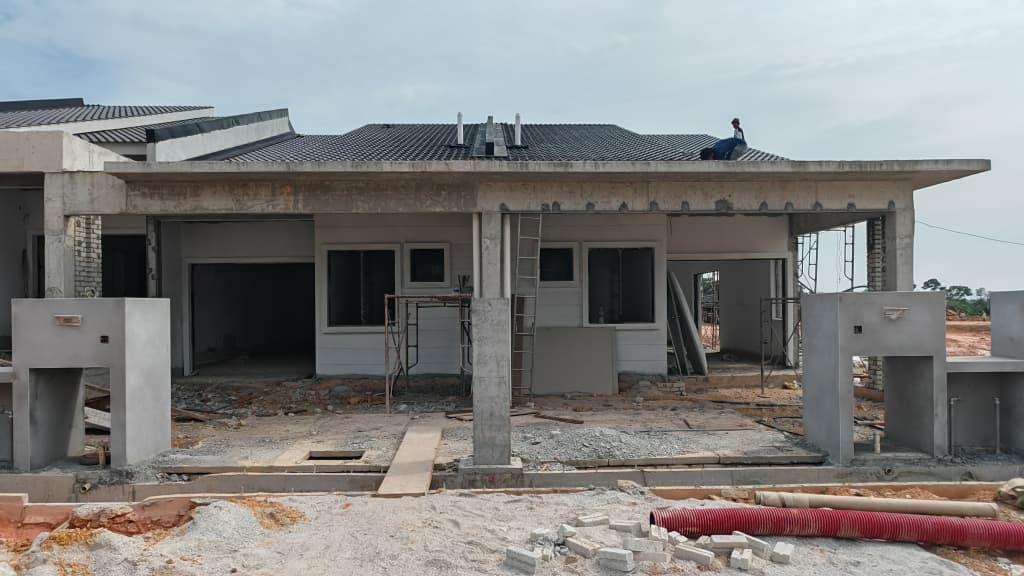

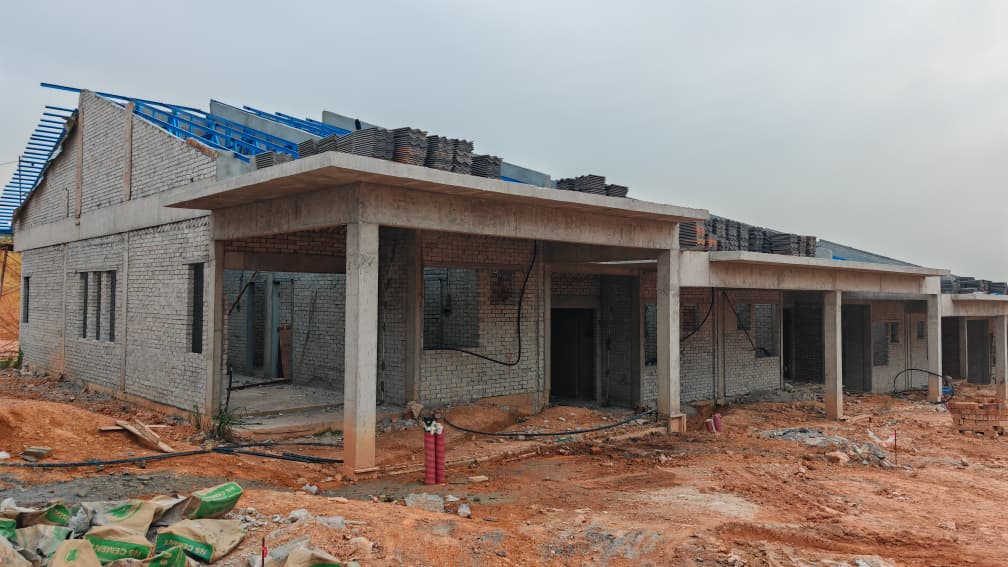

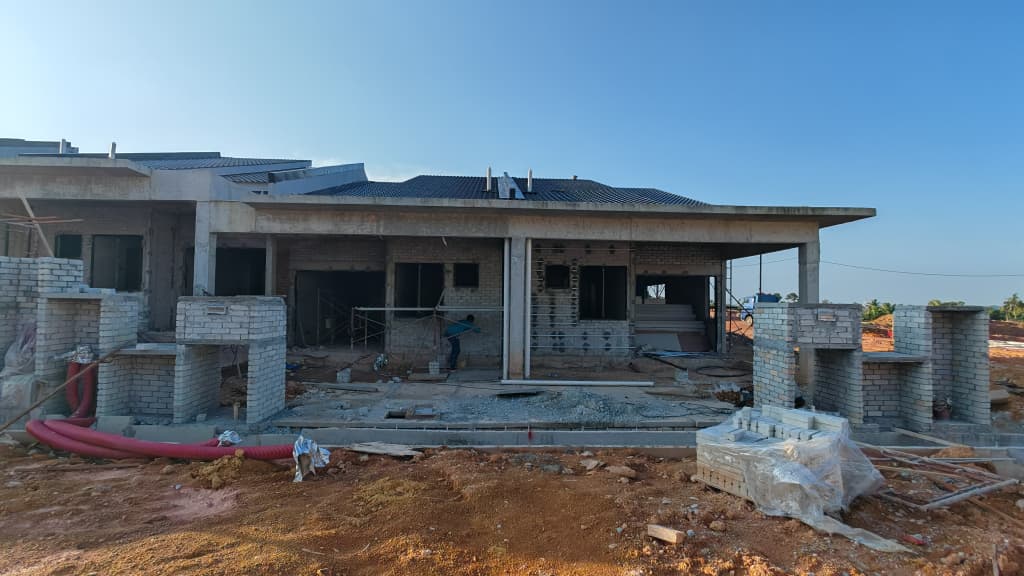

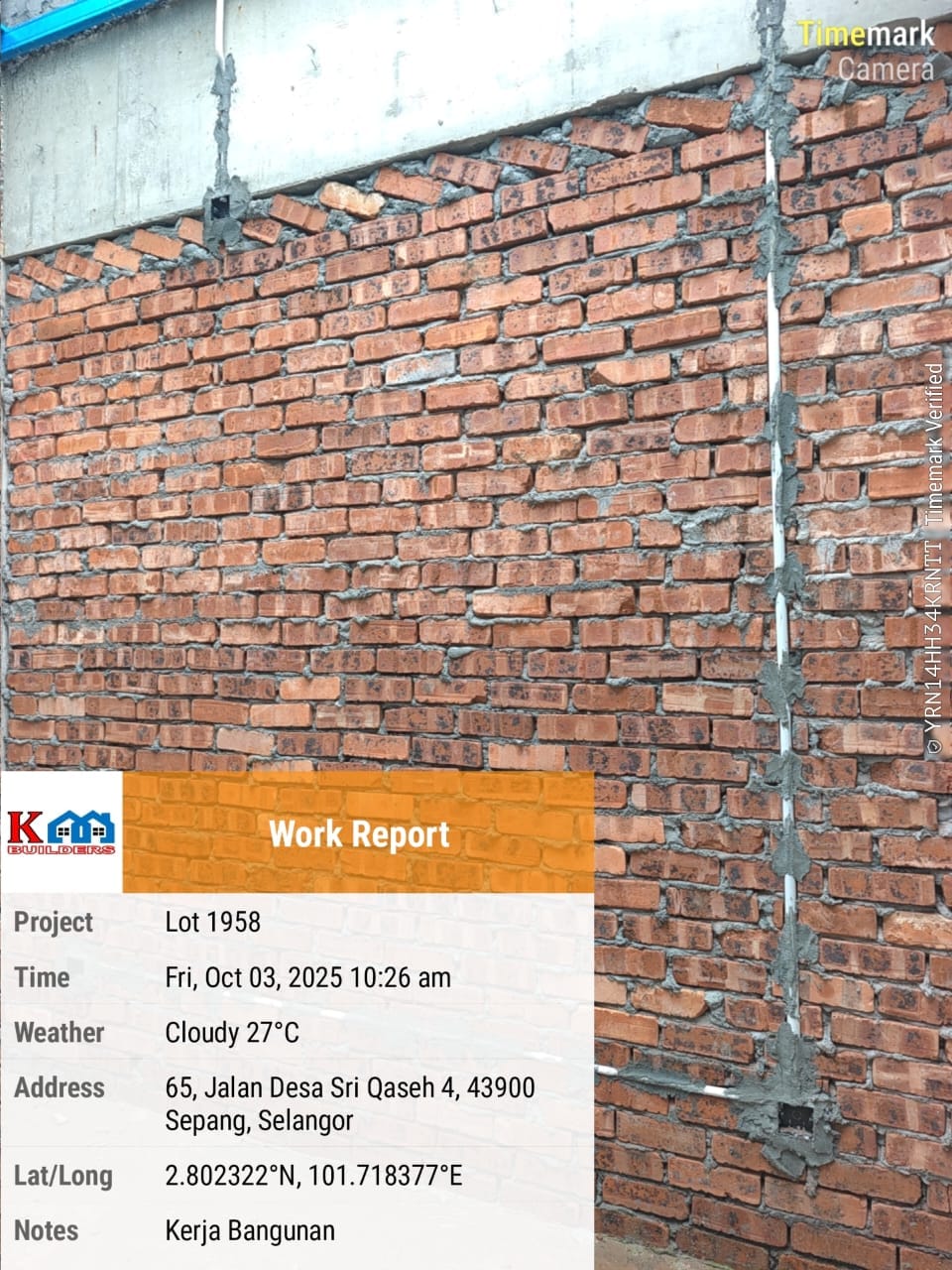

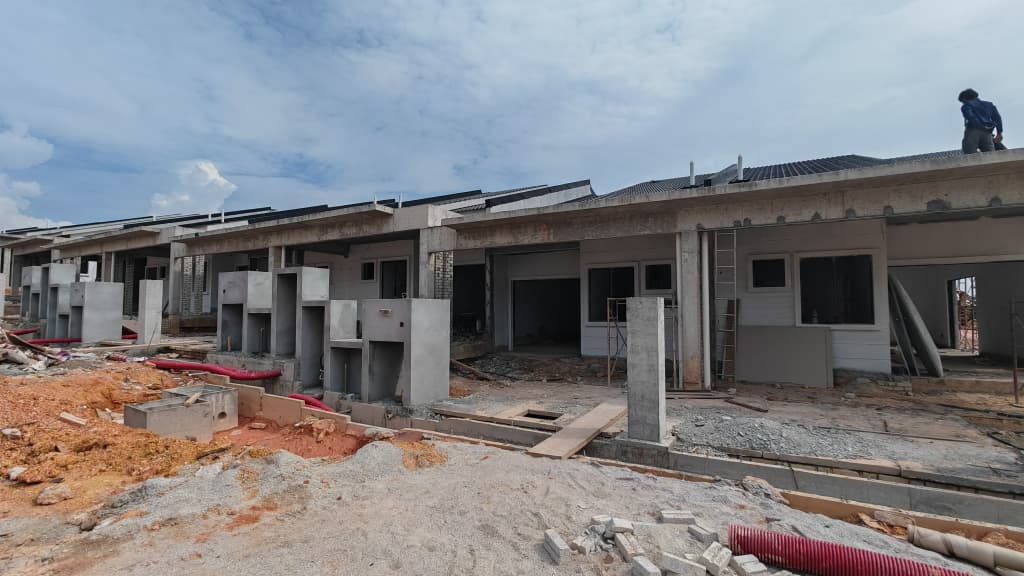

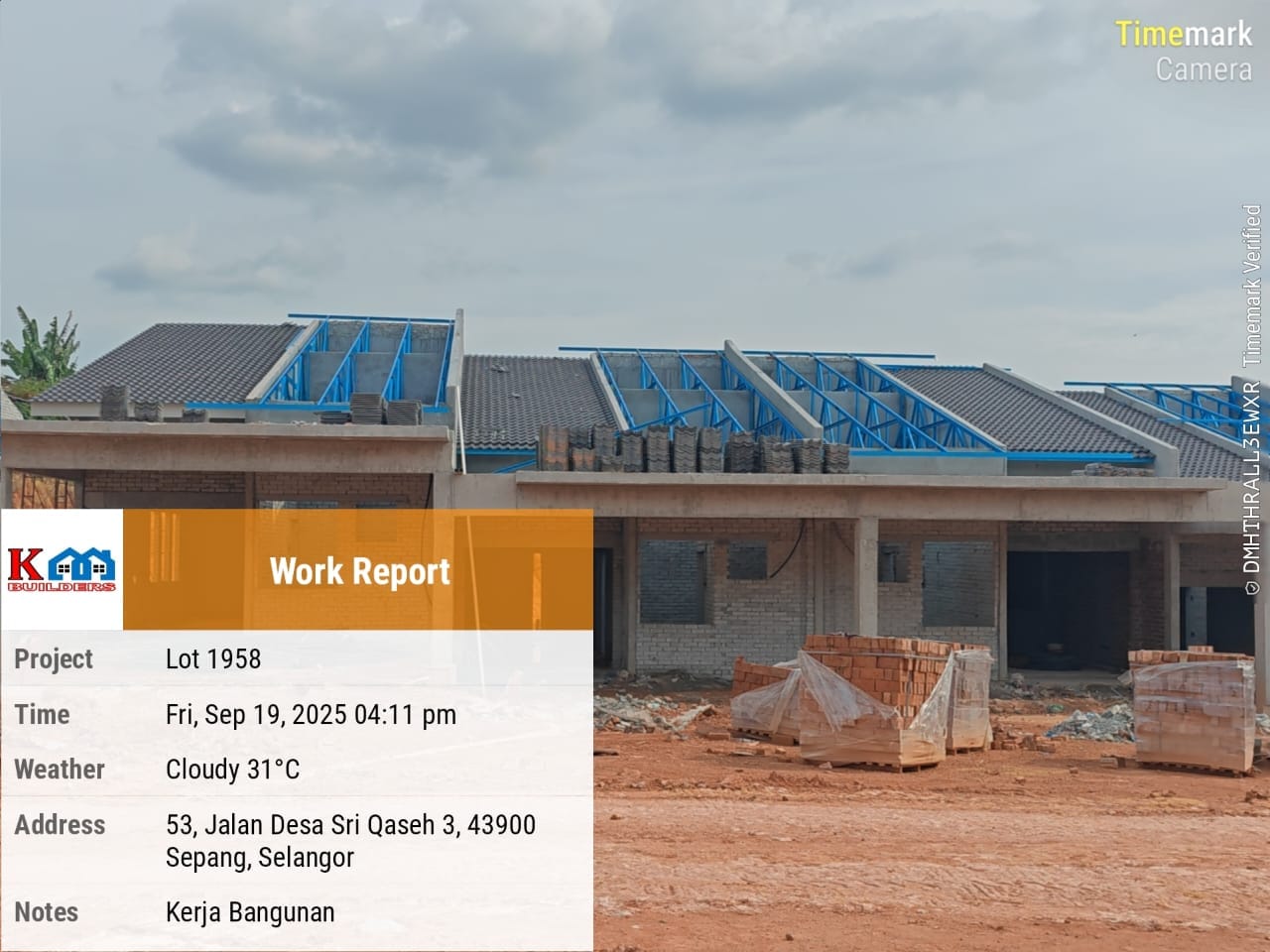

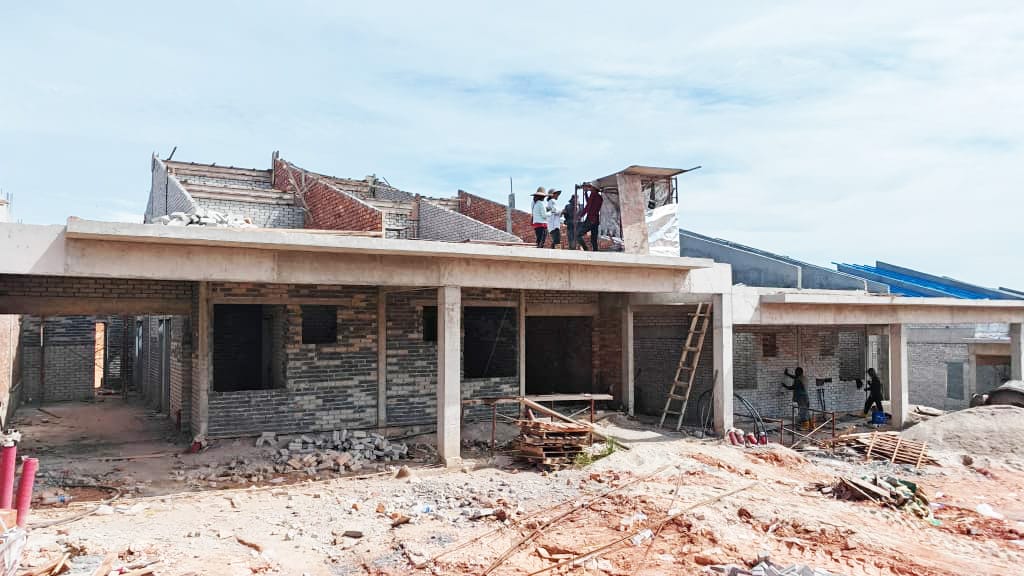

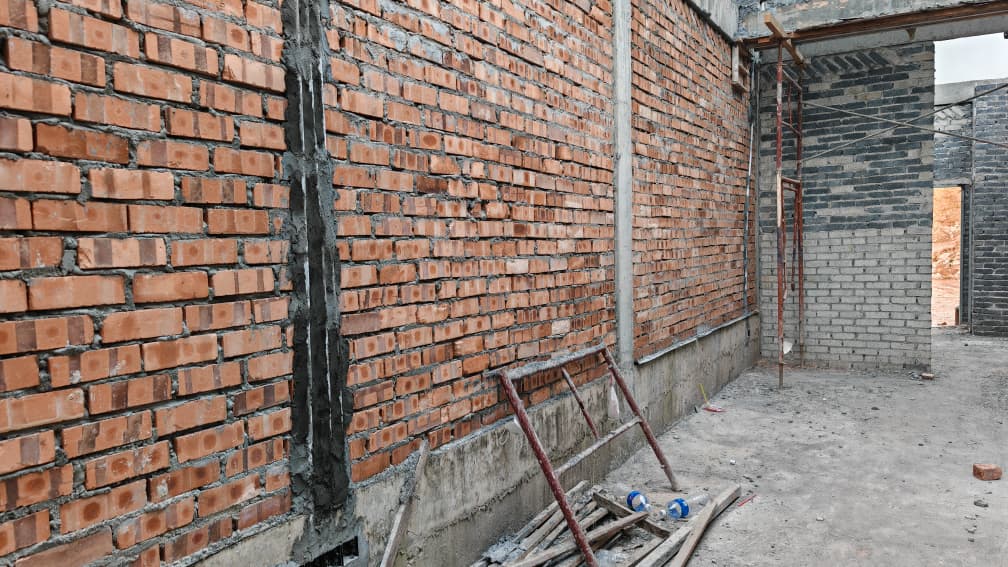

Brickworks | 28 February 2025

Brickworks | 8 March 2025

Install Underground Pipes | 2 November 2024
